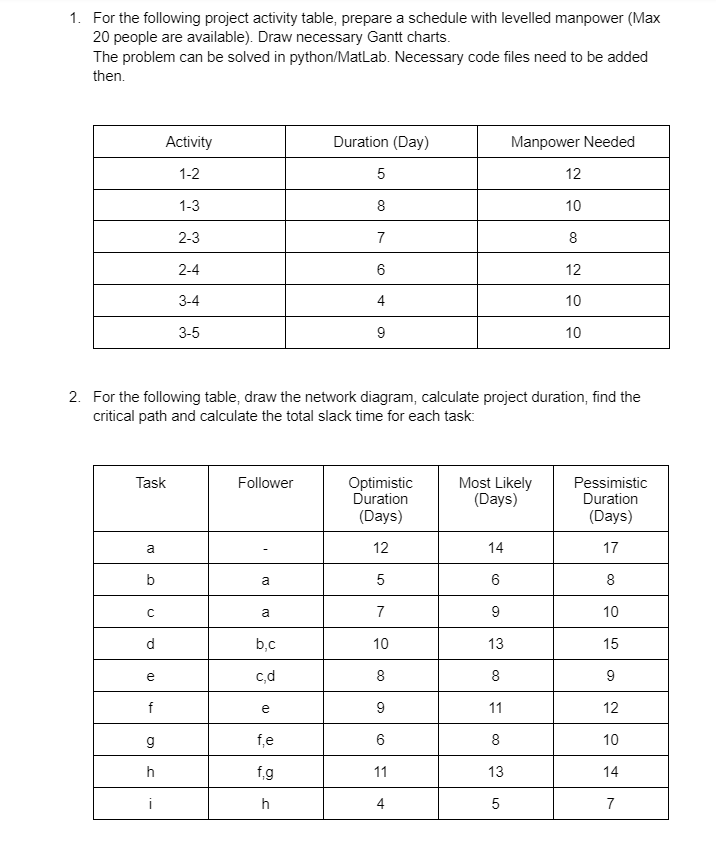

Question: 1. For the following project activity table, prepare a schedule with levelled manpower (Max 20 people are available). Draw necessary Gantt charts. The problem can

1. For the following project activity table,

1. For the following project activity table, prepare a schedule with levelled manpower (Max 20 people are available). Draw necessary Gantt charts. The problem can be solved in python/MatLab. Necessary code files need to be added then. 2. For the following table, draw the network diagram, calculate project duration, find the critical path and calculate the total slack time for each task
