Question: 1.) Identify the critical path. a) A-B-D-F b) A-C-E-F c) A-C-D-F d) A-B-E-F 2.) What is the normal project length? a) 30 b) 28 c)

1.) Identify the critical path. a) A-B-D-F b)

1.) Identify the critical path.

a) A-B-D-F

b) A-C-E-F

c) A-C-D-F

d) A-B-E-F

2.) What is the normal project length?

a) 30

b) 28

c) 24

d) 25

3.)What is the project length if all activities are crashed to their minimum?

a) 24

b) 20

c) 19

d) 23

4.Bragg's loses $3,600 in profit per week for every week the bakery is not completed. How many weeks will the project take if we are willing to pay crashing cost as long as it is less than $3,600?

a) 28 weeks

b) 27 weeks

c) 29 weeks

d) 26 weeks

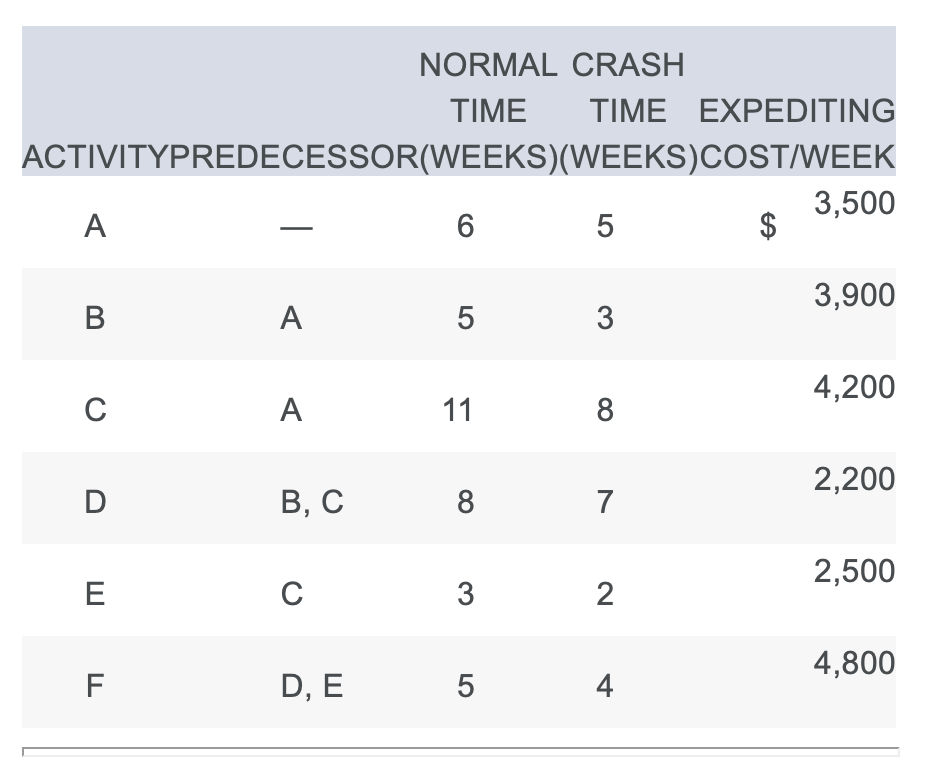

NORMAL CRASH TIME TIME EXPEDITING ACTIVITYPREDECESSOR(WEEKS)(WEEKS)COST/WEEK 3,500 A 6 5 $ 3,900 B A 5 3 4,200 A . 11 8 2,200 D B, C 8 7 2,500 3 2 4,800 D, E 5 4

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
