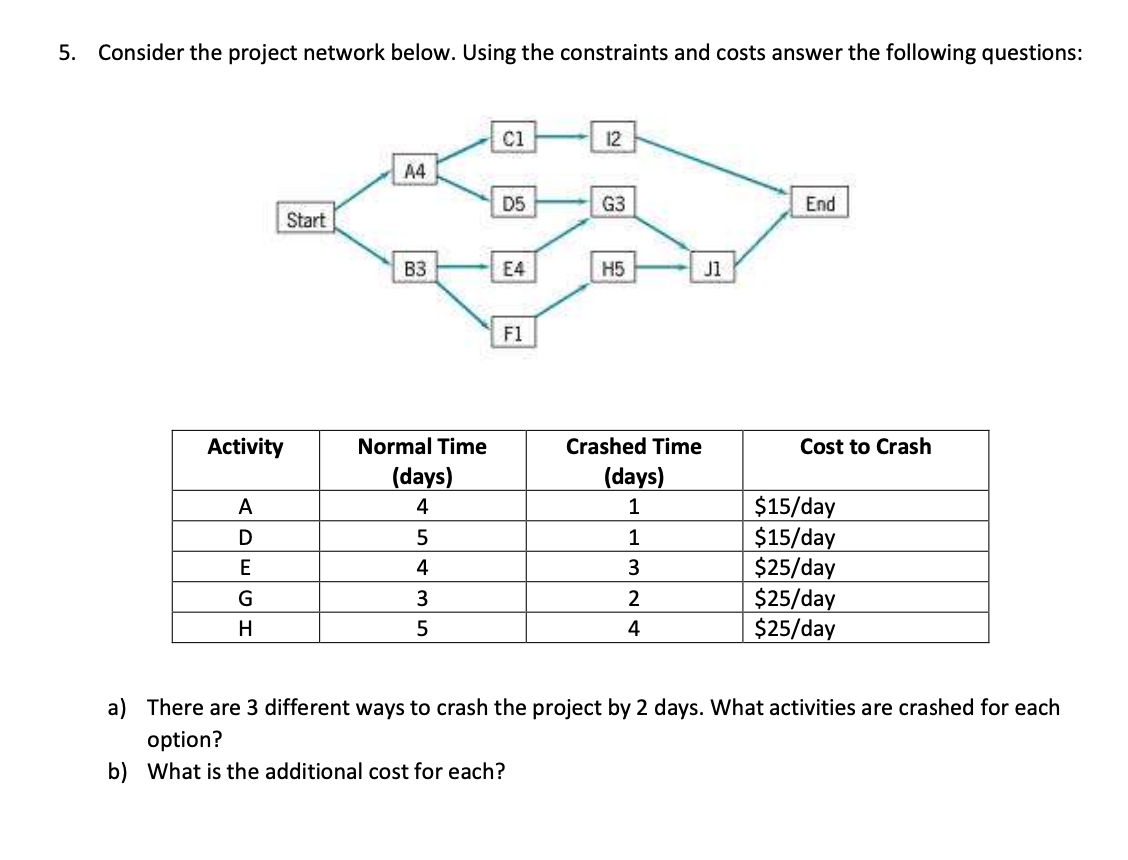

Question: 5. Consider the project network below. Using the constraints and costs answer the following questions: 12 A4 D5 G3 End Start B3 E4 H5 J1

5. Consider the project network below. Using the constraints and costs answer the following questions: 12 A4 D5 G3 End Start B3 E4 H5 J1 F1 Activity Normal Time Crashed Time Cost to Crash (days) (days) A 4 1 $15/day D 5 H $15/day E 4 3 $25/day G 3 2 $25/day H 5 4 $25/day a) There are 3 different ways to crash the project by 2 days. What activities are crashed for each option? b) What is the additional cost for each
