Question: b) Activity schedule. Activity y Optimistic (o) Most probable(M) Pessmistic (p Expected Time (o+4M+P)/6 Variance [(P-o)/6]2 A 1.5 2 2.5 2 0.03 B 2 2.5

b) Activity schedule. Activity y Optimistic (o)b) Activity schedule. Activity y Optimistic (o)

b) Activity schedule.

Activity y

Optimistic (o)

Most probable(M)

Pessmistic (p

Expected Time (o+4M+P)/6

Variance [(P-o)/6]2

A

1.5

2

2.5

2

0.03

B

2

2.5

6

3

0.44

C

1

2

3

2

0.11

D

1.5

2

2.5

2

0.03

E

0.5

1

1.5

1

0.03

F

1

2

3

2

0.11

G

3

3.5

7

4

0.44

H

3

4

5

4

0.11

I

1.5

2

2.5

2

0.33

.

c) Critical Activities

Activity

Earliest Start

Latest Start

Earliest Start

Latest Start

Slack

Critical ACTIVITY

A

0

0

2

2

0

Yes

B

2

2

5

5

0

Yes

C

0

1

2

3

1

D

2

3

4

5

1

E

5

10

6

11

5

F

6

11

8

13

5

G

5

5

9

9

0

Yes

H

9

9

13

13

0

Yes

I

13

13

15

15

0

Yes

Therefore the critical path will be ABGHI.

Expected Completion time=2+3+4+4+2=15

d) Variance of the critical path will be the sum of variances of all the critical activities:

2=0.03+0.44+0.44+0.11+0.03=1.05

At 0.99probability

z=+2.33

Z=TE(T)

Z=[T15)(1.05)12

Z=2.23

Now,

T=15+2.23(1.05)12

T=17.4 weeks

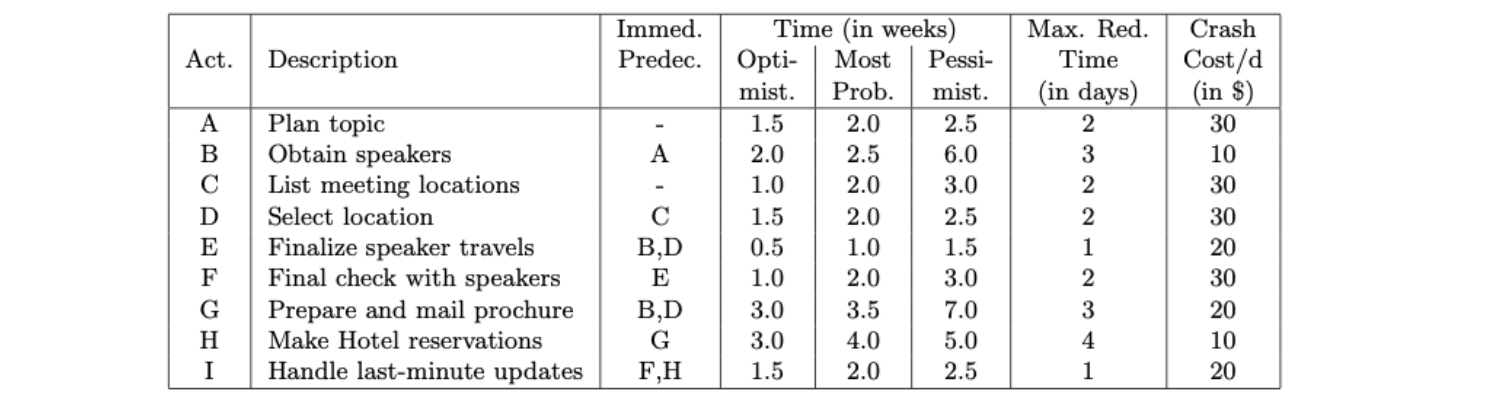

e) If the training program would be ready earlier, it could be advertised earlier and there would be more paying attendees. Therefore, it is worth to invest in crashing preparation times. By using the values of max. reduction times in days and crash costs in $ per day and the fact that a week has 5 working days, formulate and write down a linear programme model that minimizes the cost to crash the total project time by one week. \begin{tabular}{|c|l|c|c|c|c|c|c|} \hline & & Immed. & \multicolumn{2}{|c|}{ Time (in weeks) } & Max. Red. & Crash \\ Act. & Description & Predec. & OptiMost mist. & PessiProb. mist. & Time (in days) & Cost/d (in \$) \\ \hline A & Plan topic & & 1.5 & 2.0 & 2.5 & 2 & 30 \\ B & Obtain speakers & A & 2.0 & 2.5 & 6.0 & 3 & 10 \\ C & List meeting locations & & 1.0 & 2.0 & 3.0 & 2 & 30 \\ D & Select location & C & 1.5 & 2.0 & 2.5 & 2 & 30 \\ E & Finalize speaker travels & B,D & 0.5 & 1.0 & 1.5 & 1 & 20 \\ F & Final check with speakers & E & 1.0 & 2.0 & 3.0 & 2 & 30 \\ G & Prepare and mail prochure & B,D & 3.0 & 3.5 & 7.0 & 3 & 20 \\ H & Make Hotel reservations & G & 3.0 & 4.0 & 5.0 & 4 & 10 \\ I & Handle last-minute updates & F,H & 1.5 & 2.0 & 2.5 & 1 & 20 \\ \hline \end{tabular}

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
