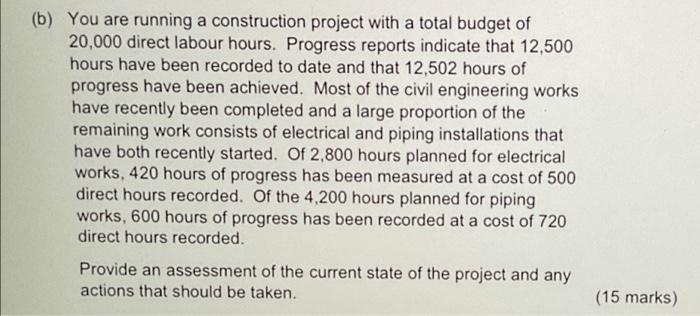

Question: (b) You are running a construction project with a total budget of 20,000 direct labour hours. Progress reports indicate that 12,500 hours have been recorded
