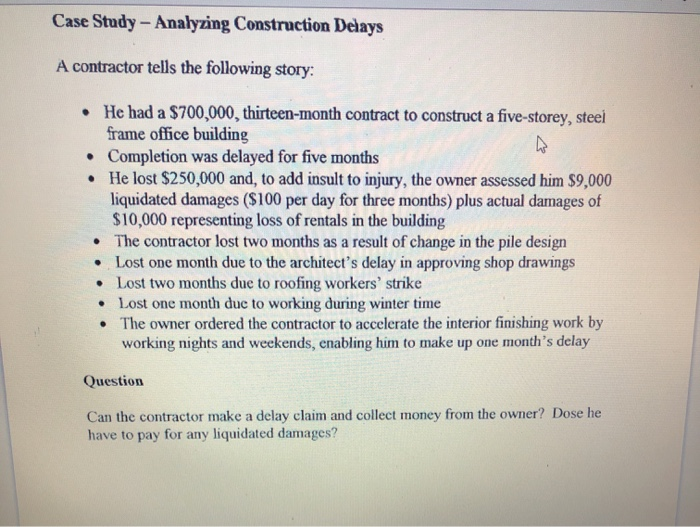

Question: Case Study - Analyzing Construction Delays A contractor tells the following story: He had a $700,000, thirteen-month contract to construct a five-storey, steel frame office
