Question: Case Study: Risk Management and Evaluation Nuclear energy is one of the possible alternative energy to meet the increasing energy demand in the world. Unlike
Case Study: Risk Management and Evaluation Nuclear energy is one of the possible alternative energy to meet the increasing energy demand in the world. Unlike coal and gas, nuclear power can be considered as clean from pollution. In this context, the UAE has increased its focus on this energy in order to comply with its vision of being a clean industrial country that sustain environment and people. As the risk manager of a project sponsored by Barakah, you are assigned the role of managing and evaluating risks that might affect the project during the execution phase. The project is scheduled to start from July 2021, it consists of power plant extension that include expanding the power plant building and installing new electrical machines to boost the produced electric power. During a brain storming session, you discovered that the current pandemic, due the COVID-19, could be a triggering event that might lead to the occurrence of several risky events. The following represents data about the project prior to the risk study: Activity Description Immediate Predecessor Activity Time : T (in days) A 5 B 6 8 D 12 E 20 F 16 Plant specifications study

II: Risk Assessment In order to evaluate the possible risk impact on the project completion, you have conducted a research (using the four risk events you already listed in part I) that have led to the following results: If one risk event occurs during any activity then it will delay the activity buy 2 days. Hence, and in order to apply the PERT technique, you will define three time estimates as following: To: The activity time: T (from the table) Tm: T + Delay from the occurrence of two risk events Tp: T + Delay from the occurrence of four risk events Questions: 1. Draw the project AON diagram and compute the three time estimates for each activity.
2. What is the expected time of each activity?
Questions:
3. What are the activities on the critical path?

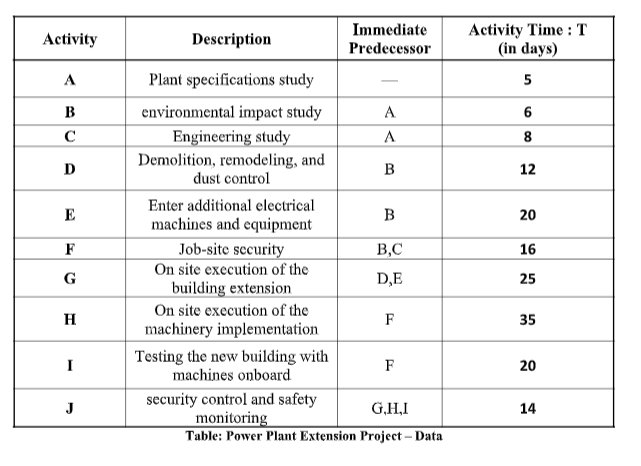

Activity Description Immediate Predecessor Activity Time : T (in days) A 5 B 6 8 D 12 E 20 F 16 Plant specifications study environmental impact study A Engineering study A Demolition, remodeling, and B dust control Enter additional electrical B machines and equipment Job-site security B,C On site execution of the DE building extension On site execution of the F machinery implementation Testing the new building with F machines onboard security control and safety GHI monitoring Table: Power Plant Extension Project - Data G 25 H 35 20 14 0 O O 0 E A C H G O A B C D Tm Tp 1 Activity 2 A 5 9 13 3 B 6 10 14 4 C 8 12 16 5 D 12 16 20 E F Expected time Variance Path Expected time Variance 9 1.777777778 A-B-D-G-J 82 10 1.777777778 A-B-E-G-) 90 12 1.777777778 A-B-F-H-J 96 16 1.777777778 A-C-F-H-) 98 8.888889 24 1.777777778 A-C-F-I-J 83 20 1.777777778 29 1.777777778 39 1.777777778 24 1.777777778 18 1.777777778 6 E 20 24 28 7 F 16 20 24 8 G 25 29 33 9 H 35 39 43 20 24 28 100 11 ) 14 18 22 12Step by Step Solution
There are 3 Steps involved in it
Get step-by-step solutions from verified subject matter experts
