Question: Computing Total &Free Slack in the Basic Formulation Task LS-ES= Total Slack (Min ES's of successors)-EF= Free Slack Task LS-ES= Total Slack (Min ES's of

Computing Total &Free Slack in the Basic Formulation
Task LS-ES= Total Slack (Min ES's of successors)-EF= Free Slack Task LS-ES= Total Slack (Min ES's of successors)-EF= Free Slack

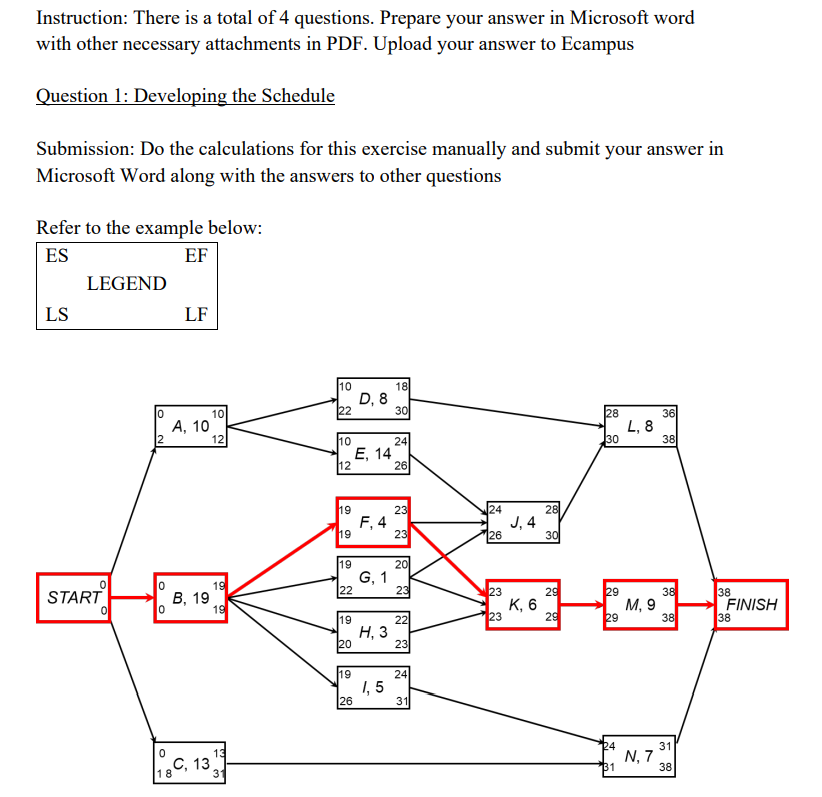

A 2-0=2 min {10, 10} - 10 = 0 I 26 - 19 = 7 24 - 24 = 0
B 0-0=0 min {19, 19, 19, 19} - 19 J 26 - 24 = 2 28 - 28 = 0
C 18-0=18 24 - 13 = 11 K 23 - 23 = 0 29 - 29 = 0
D 22 - 10 = 12 28 - 18 = 10 L 30 - 28 = 2 38 - 36 = 2
E 12 - 10 = 2 24 - 24 = 0 M 29 - 29 = 0 38 - 38 = 0
F 19 - 19 = 0 "min {24,23} - 23" N 31 - 24 = 7 38 - 31 = 7
G 22 - 19 = 3 "min {24,23} - 20"
H 20 - 19 = 1 23 - 22 = 1
 Computing Total &Free Slack in the Basic Formulation Task LS-ES= Total

Slack (Min ES's of successors)-EF= Free Slack Task LS-ES= Total Slack (Min

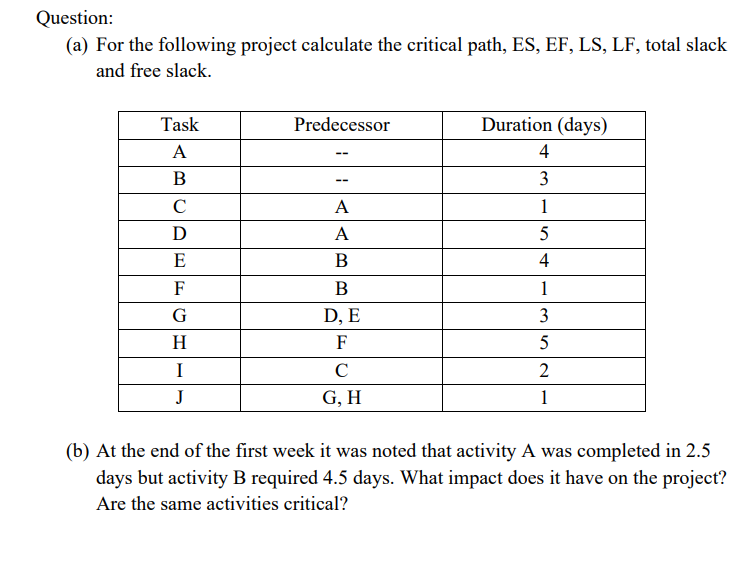

Instruction: There is a total of 4 questions. Prepare your answer in Microsoft word with other necessary attachments in PDF. Upload your answer to Ecampus Question 1: Developing the Schedule Submission: Do the calculations for this exercise manually and submit your answer in Microsoft Word along with the answers to other questions Refer to the example below: Question: (a) For the following project calculate the critical path, ES, EF, LS, LF, total slack and free slack. (b) At the end of the first week it was noted that activity A was completed in 2.5 days but activity B required 4.5 days. What impact does it have on the project? Are the same activities critical

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
