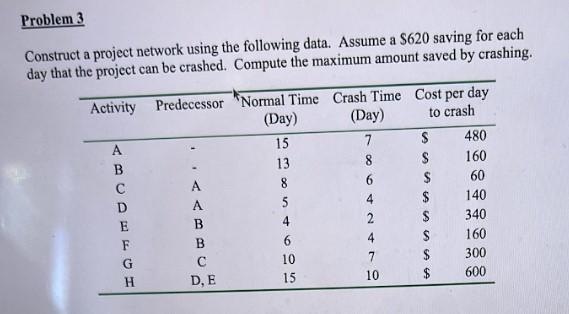

Question: Construct a project network using the following data. Assume a $620 saving for each day that the project can be crashed. Compute the maximum amount

Construct a project network using the following

Construct a project network using the following data. Assume a $620 saving for each day that the project can be crashed. Compute the maximum amount saved by crashing
