Question: Context, data, and previous steps with results to help you answer the questions I'm asking: -------------------------------------------------------------------------------------------------------------------------------------------------------------------- Red Zuma Project Part 4 Status as of 7/8/2014.
Context, data, and previous steps with results to help you answer the questions I'm asking:

--------------------------------------------------------------------------------------------------------------------------------------------------------------------
Red Zuma Project Part 4

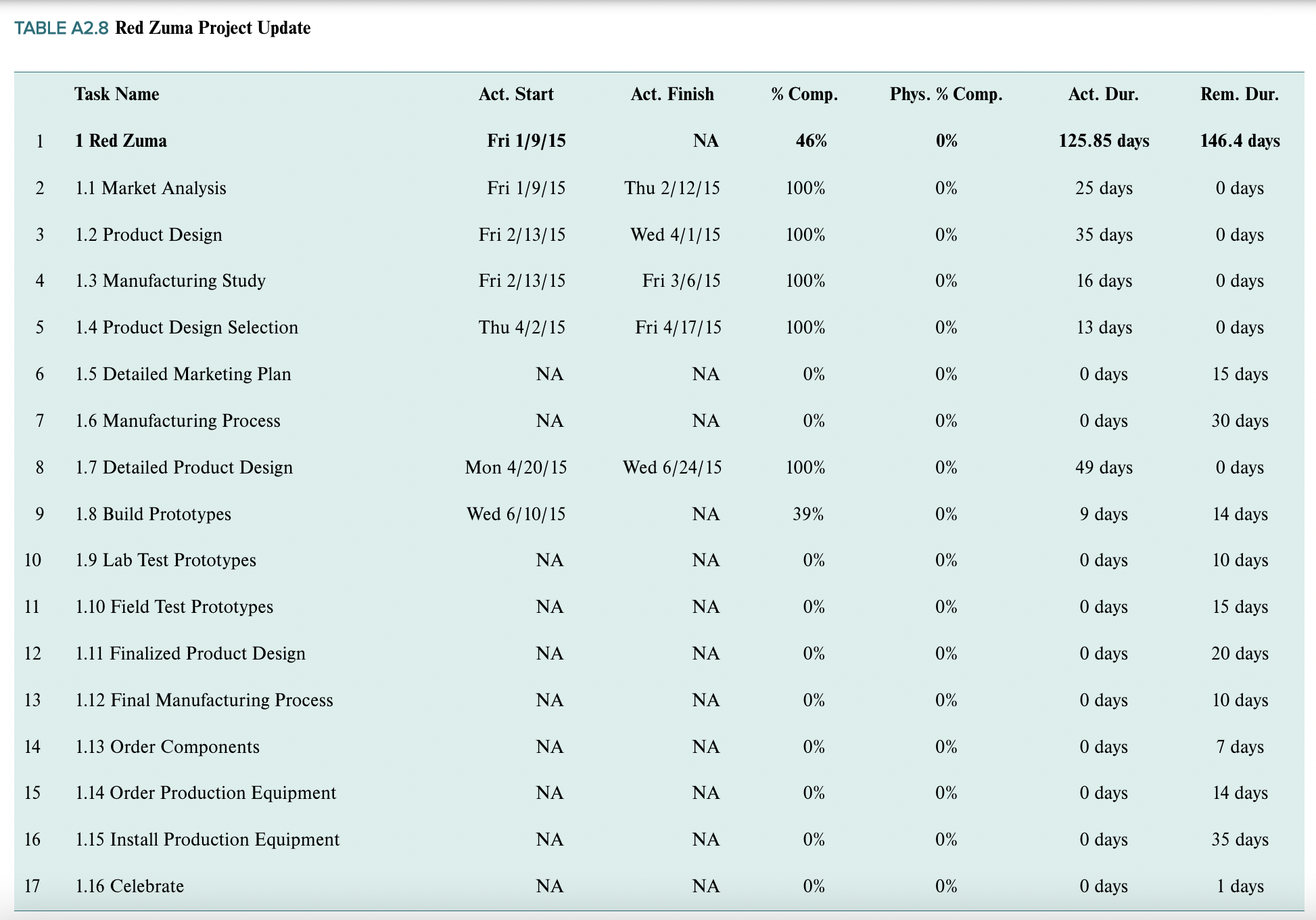

Status as of 7/8/2014. Use Table A2.8 in text to make status updates before answering.

Q.4.A. Provide the value ($USD) and explain the Estimate at Completion (EAC) of the project at this status date. ______________.
Q.4.B. What is the SPI at this status date. ___________.
Q.4.C. What does this SPI value indicate? ___________.
Q.4.B. What is the CPI at this status date. ___________.
Q.4.C. What does this CPI value indicate? ___________.
Q.5.D. On what date will the project finish? MM/DD/YYYY

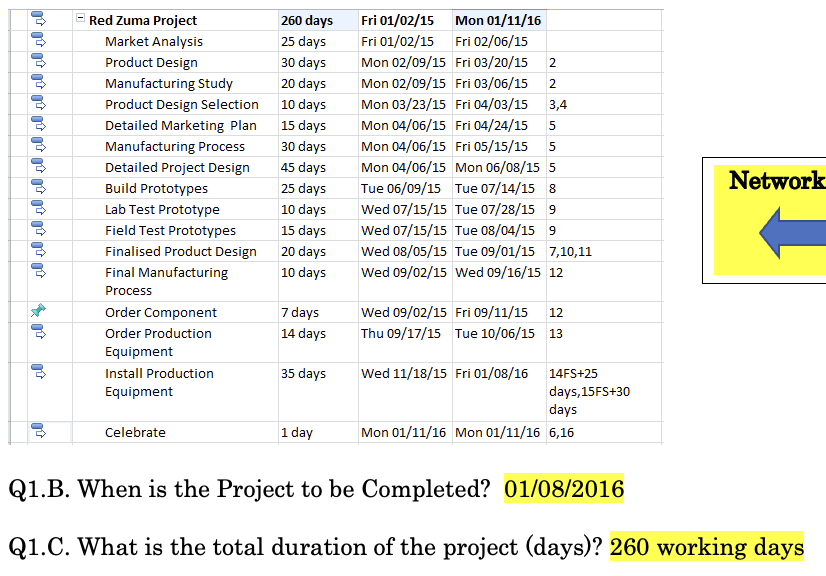

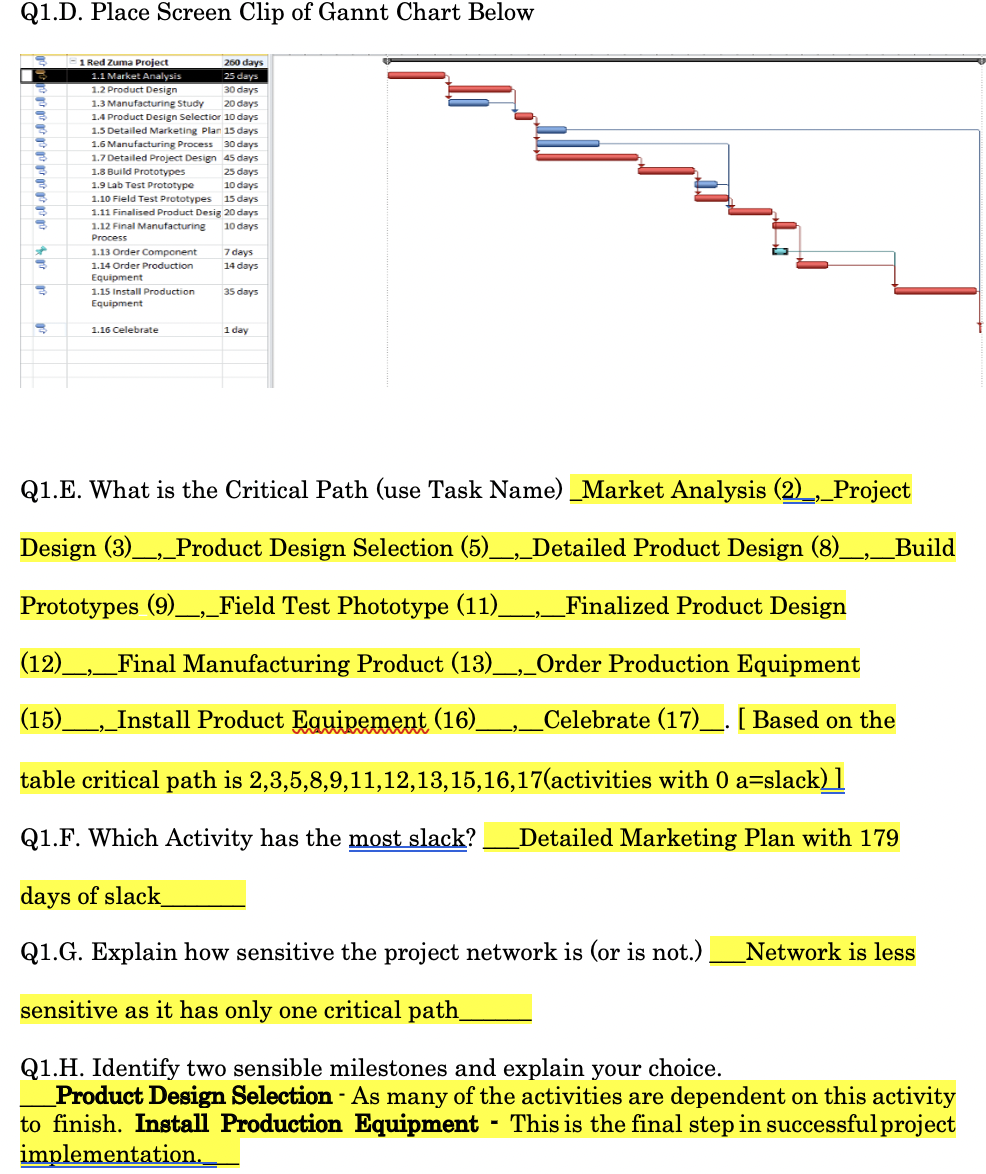

Q1.B. When is the Project to be Completed? 01/08/2016 Q1.C. What is the total duration of the project (days)? 260 working days Q1.D. Place Screen Clip of Gannt Chart Below Q1.E. What is the Critical Path (use Task Name)_Market Analysis (2)__PProject Design (3)_,_Product Design Selection (5)_,_Detailed Product Design (8)_,_Build Prototypes (9)___Field Test Phototype (11)____Finalized Product Design (12)___Final Manufacturing Product (13)_,_Order Production Equipment (15)___Install Product Equipement (16)_,_Celebrate (17)_. table critical path is 2,3,5,8,9,11,12,13,15,16,17 (activities with 0 a=slack l Q1.F. Which Activity has the most slack? Detailed Marketing Plan with 179 days of slack Q1.G. Explain how sensitive the project network is (or is not.) sensitive as it has only one critical path Q1.H. Identify two sensible milestones and explain your choice. Product Design Selection - As many of the activities are dependent on this activity to finish. Install Production Equipment - This is the final step in successful project implementation. Specialist Design Engineer _,_Industrial Engineer. Q2.B. After Leveling "Within Slack", which resource(s) are over-allocated? (Level Within Slack, Do Not Split Activities) Design Engineer___Industrial Q2.C. After Leveling, what is the new duration and completion date? Duration: 295 days Completion 03/01/2016 Q3. Add the schedule changes described in Part B. Baseline your project (Project > Set Baseline) and answer the following: Q.3.A. What does the project cost? Q.3.B. What is the most expensive activity? detailed product design How much? $190,168 TABLE A2.8 Red Zuma Project Update
