Question: Determine the critical path, then determine the float time for all activities not on critical path Consider the set of activities, duration (in days), and

Determine the critical path, then determine the float time for all activities not on critical path Determine the critical path, then determine the float time for all activities

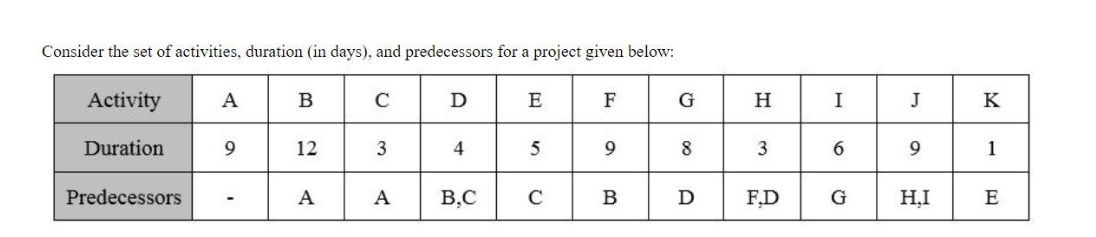

Consider the set of activities, duration (in days), and predecessors for a project given below
