Question: Develop an estimated duration for each activity based on the dates described in the study case. Responses should use the list of tasks developed in

Develop an estimated duration for each activity

Develop an estimated duration for each activity based on the dates described in the study case.

Responses should use the list of tasks developed in chapter 4 and include the estimated duration for each task.

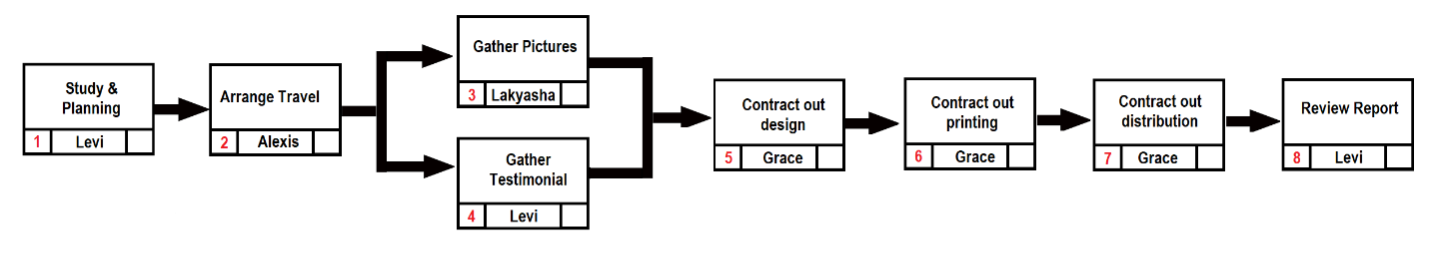

Activity

Responsibility

Immediate predecessors

Estimated Duration

(Days)

1

Study and Planning

Levi

----

30

2

Arrange Travel

Alexis

Study and planning

31

3

Gather Pictures

Lakyasha

Arrange Travel

30

4

Gather Testimonial

Levi

Arrange Travel

31

5

Contract Out Design

Grace

Gather Pictures, Gather Testimonial

31

6

Contract Out Printing

Grace

Contract Out Design

30

7

Contract Out Distribution

Grace

Contract Out Printing

31

8

Review Report

Levi

Contract Out Distribution

14

Using a project start time of 0 (or May 15) and a required project completion time of 180 days (or November 15), calculate the ES, EF, LS, and LF times and total slack for each activity. If your calculations result in a project schedule with total negative slack. Responses could be presented in a network diagram or in the schedule table format. The project should finish in 180 days. If the original plan is not completed by 180 days, the responses should describe what tasks were revised to meet the required completion date. Also, determine the critical path and identify the activities that make up the critical path.

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
