Question: - Everything is correct up until the table asking for LS and LF, I'm just not sure how to fill that table out for each

- Everything is correct up until the table asking for LS and LF, I'm just not sure how to fill that table out for each activity.

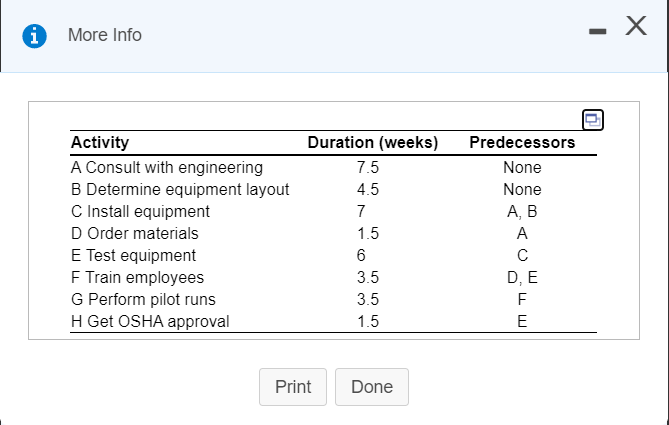

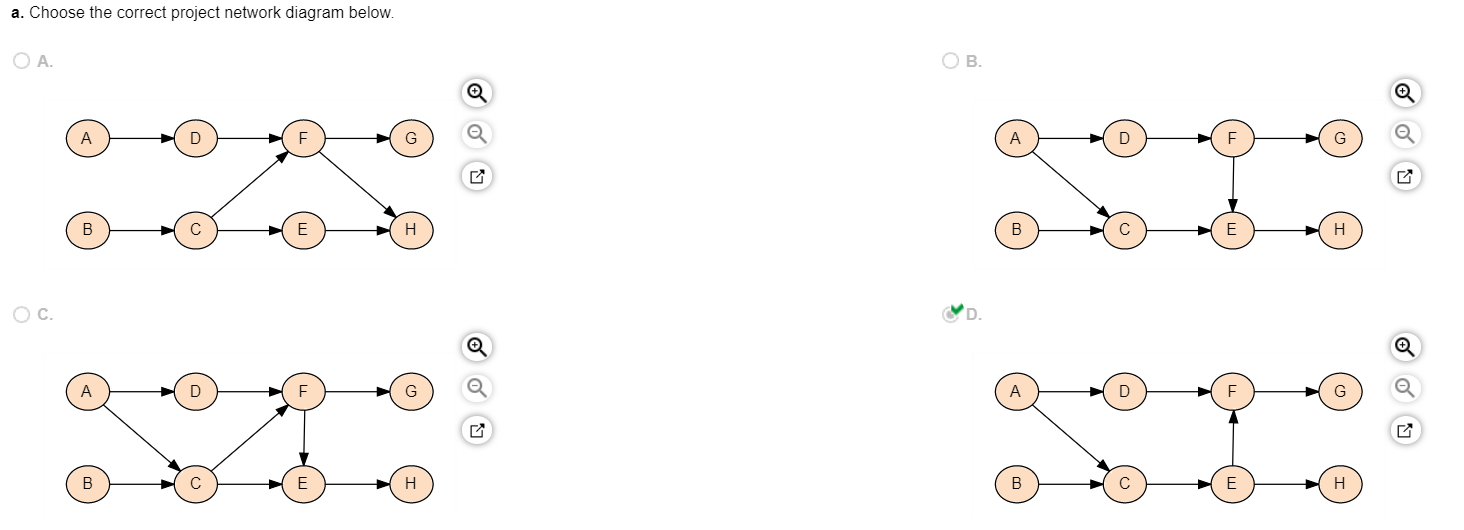

After graduation, you and several of your friends decide to start a new software company. As the vice president of operations, you are in charge of several production steps, including the process of recording software onto a CD. You have identified several activities that must take place before this "burn-in" process is ready to use Click the icon to view the activities. i More Info - n Duration (weeks) 7.5 4.5 7 Activity A Consult with engineering B Determine equipment layout C Install equipment D Order materials E Test equipment F Train employees G Perform pilot runs H Get OSHA approval 1.5 6 3.5 3.5 1.5 Predecessors None None A,B A DE F E Print Done a. Choose the correct project network diagram below. OA OB A D G D F C E . E . OC. A D G A D E H B E H Calculate the early start and early finish times for each activity. Fill in the table below (enter your responses rounded to one decimal place). Activity ES EF Duration (weeks) Predecessors 7.5 None A 0 7.5 4.5 B 4.5 None 0 7 AB 7.5 14.5 D 1.5 A 7.5 9 E 6 C 14.5 20.5 F 3.5 D, E 20.5 24 G 3.5 F 24 27.5 . 1.5 E 20.5 22 Calculate the late start and late finish times for the each activity performing the backward pass. Fill in the table below (enter your responses rounded to one decimal place). Activity LS LF Duration (weeks) Predecessors 1.5 E HStep by Step Solution
There are 3 Steps involved in it
Get step-by-step solutions from verified subject matter experts
