Question: For each problem, provide a table showing (for each activity in the network): - Early Start Time (ES) - Early Finish Time (EF) - Late

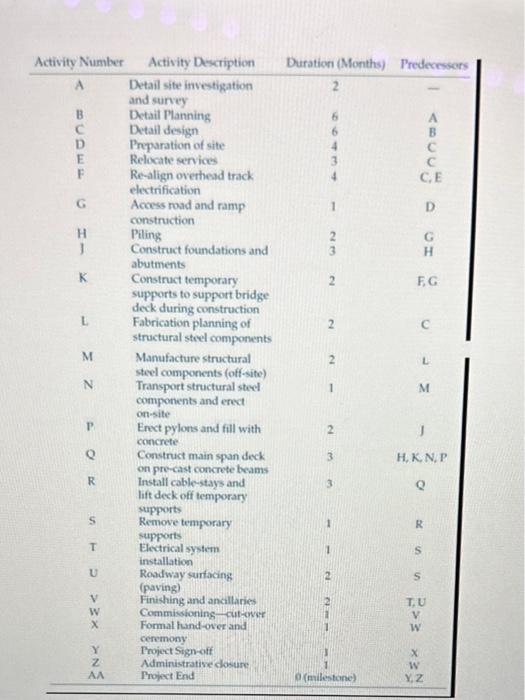

For each problem, provide a table showing (for each activity in the network): - Early Start Time (ES) - Early Finish Time (EF) - Late Start Time (LS) - Late Finish Time (LF) - Total Float (TF) - Resource loadings (as appropriate) Be sure your network diagrams and Gantt charts are neat and legible. 1. The table on the next page lists astivities for constructing a bridge over an operational railway line: a. Draw the network diagram for the project b. Do forward and backward pass calculations to indicate the ES, EF, LS, and LF c. Indicate(highlight) the critical path d. Indicate the TF and Free Float (FF) of each activity
