Question: Hi can you please provide a three level Work Breakdown Structure (WBS) for the case study below. Thank you! PROJG002 Case Study Property Condition Program
Hi can you please provide a three level Work Breakdown Structure (WBS) for the case study below. Thank you!

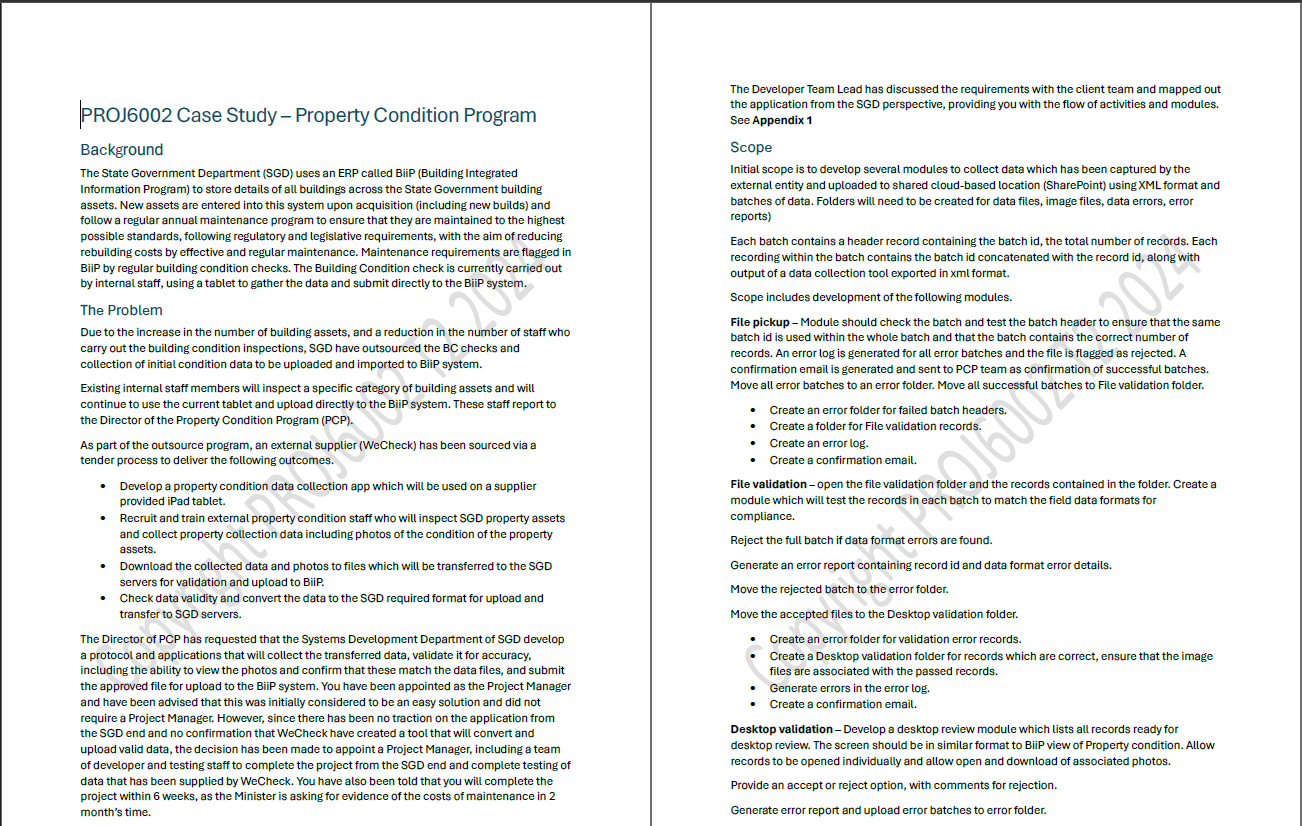

PROJG002 Case Study Property Condition Program Background The State Government Department (SGD) uses an ERP called BiiP (Building Integrated Information Program) to store details of all buildings across the State Government building assets. New assets are entered into this system upon acquisition (including new builds) and follow a regular annual maintenance program to ensure that they are maintained to the highest possible standards, following regulatory and legislative requirements, with the aim of reducing rebuilding costs by effective and regular maintenance. Maintenance reguirements are flagged in BiiP by regular building condition checks. The Building Condition check is currently carried out by internal staff, using a tablet to gather the data and submit directly to the BiiP system. The Problem Due to the increase in the number of building assets, and a reduction in the number of staff who carry out the building condition inspections, SGD have outsourced the BC checks and collection of initial condition data to be uploaded and imported to BiiP system. Existing internal staff members will inspect a specific category of building assets and will continue to use the current tablet and upload directly to the BiiP system. These staff report to the Director of the Property Condition Program (PCP). As part of the outsource program, an external supplier (WeCheck) has been sourcedviaa tender process to deliver the following outcomes. * Develop a property condition data collection app which will be used on a supplier provided iPad tablet. * Recruit and train external property condition staff who will inspect SGD property assets and collect property collection data including photos of the condition of the property assets. * Download the collected data and photos to files which will be transferred to the SGD servers for validation and upload to BiiF. * Checkdata validity and convert the data to the SGD reguired format for upload and transfer to SGD servers. The Director of PCP has requested that the Systems Development Department of SGD develop a protocol and applications that will collect the transferred data, validate it for accuracy, including the ability to view the photos and confirm that these match the data files, and submit the approved file for upload to the BiiP system. You have been appointed as the Project Manager and have been advised that this was initially considered to be an easy solution and did not require a Project Manager. However, since there has been no traction on the application from the SGD end and no confirmation that WeCheck have created a tool that will convert and upload valid data, the decizion has been made to appoint a Project Manager, including a team of developer and testing staff to complete the project from the SGD end and complete testing of data that has been supplied by WeCheck. You have also been told that you will complete the project within 6 weeks, as the Minister is asking for evidence of the costs of maintenance in 2 month's time. The Developer Team Lead has discussed the requirements with the client team and mapped out the application from the SGD perspective, providing you with the flow of activities and modules. See Appendix 1 Scope Initial scope is to develop several modules to collect data which has been captured by the external entity and uploaded to shared cloud-based location (SharePoint) using XML format and batches of data. Folders will need to be created for data files, image files, data errors, error reports) Each batch contains a header record containing the batch id, the total number of records. Each recording within the batch contains the batch id concatenated with the record id, along with output of a data collection tool exported in xml format. Scope includes development of the following modules. File pickup Module should check the batch and test the batch header to ensure that the same batch id is used within the whole batch and that the batch contains the correct number of records. An error log is generated for all error batches and the file is flagged as rejected. A confirmation email is generated and sent to PCP team as confirmation of successful batches. Move all error batches to an error folder. Move all successful batches to File validation folder. * Create an error folder for failed batch headers. * Create afolder for File validation records. * Create an error log. * Create a confirmation email. File validation open the file validation folder and the records contained in the folder. Create module which will test the records in each batch to match the field data formats for compliance. Reject the full batch if data format errors are found. Generate an error report containing record id and data format error details. Move the rejected batch to the error folder. Move the accepted files to the Desktop validation folder. * Create an error folder for validation error records. * Create a Desktop validation folder for records which are correct, ensure that the image files are associated with the passed records. * Generate errors in the error log. s Create a confirmation email. Desktop validation Develop a desktop review module which lists all records ready for desktop review. The screen should be in similar format to BiiP view of Property condition. Allow records to be opened individually and allow open and download of associated photos. Provide an accept or reject option, with comments for rejection. Generate error report and upload error batches to error folder. * Develop a desktop review module. * Create an error folder for desktop validation errors records and attach image files and error comments. * General errors in the error log and include comments. s Create an accepted log for validation against records uploaded to BiiP Data approval - User selects the Approve option and schedules the file for upload to BiiP. Files are uploaded overnight. Confirmation report is generated on successful upload of records to BiiP. Confirmation report is emailed to PCP team. Error log is generated and emailed to PCP team for failed uploads. Failed records are returned to Error folder for further review. These records should be available in Desktop Review module as Failed Upload records with error message attached. * Create error folder for failed uploads. * Create email for successful uploads. * Create email for failed uploads. Reporting - Successful transfer generates a confirmation message in Desktop Review Application, failed transfer generates a failure message in Desktop Review Application and creates an error log. * Create successful upload message in Desktop Review Application log s Create failed upload message in Desktop Review Application log * Further reports to be specified and generated post implementation. Quality Quality of data captured by external entity, ensuring that it matches the key attributes of the new database into which the data will be uploaded. Quality of data transfer protocol, ensuring that batches of data uploaded and collected match the header record identifying the records to be collected. Process quality - ensuring that data collected is valid, dsta capture is efficient and results in zero batches rejected, quality of data and associated artefacts, e.g. photos, comrect data formats, data has been completed correctly, data is valid (set auto and manual checks) Quality control requirements Test team will develop a Reguirements Traceability Matrix (RTM) to track the requirements and the test scripts. Test team will develop Test Scripts for all modules. Test team will develop test data for testing data validation in preparation for final test using live data. Final test prior to go live requires all records to be correctly captured, validated for file correctness, validated for data correctness, viewable within the desktop view, including attachments, allowing acceptance or rejection, and accepted records need to successfully be uploaded to the BiiP application. Error reports are to be generated, emailed to a test email address and reports to be loaded to the relevant SharePoint folders. Acceptance is basedona defined number of correct records processed end-to-end and confirmed by the PCP team. Final testing must include live data collected from WeCheck to ensure that the data is collected and transferred by WeCheck passes all validation tests. SGD and the project are not responsible for creation or development of the WeCheck data collection tools, but will provide 'WeCheck with the data validation rules and the xmil layout that must be used for data collection and transfer. Schedule The schedule is based on the Work Breakdown Structure developed from the list of activities and needs to ensure that the project is developed and tested ready for hand-over within the required six-week timeframe. Cost The allocated budget for this project is $250,000 including development and testing of the modules as identified by the SGD Development Team lead. Please see Appendix 3 for resources, costs and responsibilities. Internal resources are excluded from the Project Costs and Budget as they are employees and charged to the SGD cost centre. External employees are included in costs for the project and are costed at daily rate plus 15%. External employees are invoiced weekly. Costs should include external resources and contingencies. Appendix 1 Files picked up and confirmed Process flow and associated modules. Error report generated File pickup . Confirmation report generated . data is validated against file and BiiP rules Error report is generated File validation PCP notification of success WeCheck WeCheck validate and WeCheck create files transfer file to convert data (txt and image for SGD servers transfer for pickup and . data is opened and viewed including images for validation against logical rules Desktop test validation . Data is approved Data . File is submitted for load to Blip approval WeCheck . Success report emailed to PCP WeCheck data header Reporting . error report emailed to PCP data nader and files 1 and files 2/ WeCheck PROX data header and files 3 SGD PCP SharePoint Server Cop CopyAppendix 2 B5.7 released to test 0 days 42 B6 INTEGRATION Project Activities list, dependencies and durations B6.1 develop integration code for module 1 4 days 14 PCP DATA COLLECTION AND VALIDATION PROJECT Predecessor 86.2 develop integration code for module 2 4 days 23 86.3 develop integration code for module day 34 AINFRASTRUCTURE $6.4 develop integration code for module 4 4 days 42 A1 confirm infrastructure requirements 5days 8 days 14;23;34:42;45;46;47:48 A2 confirm infrastructure availability 5 days 86.5 system test 49 A3 set up logins and passwords days B6.6 released to test 0 days A4 test logins and passwords 2 days 87 Development complete 0 days 15;24;35;43;50 B DATA COLLECTION AND VALIDATION MODULES C TESTING B1 confirm requirements and process flow 3 days 3SS C1 Test Centre Setup 2 days 8 B2 File pickup module C2 onboard external test contractors 2 days 53 B2.1 create folders for errors and validation records 3 develop test scripts 20 days 54 2 days 8 10 C4 develop test data 15 days 55 B2.2 develop batch header test code 3 days B2.3 develop error log 1 day 11 C5 Acceptance Testing B2.4 create emails 2 days 12 C5.1 test File pickup module 10 days 15 B2.5 system test 5 days 13 C5.2 test file validation module 10 days 24 0 days 14 C5.3 test desktop validation module 10 days 35 B2.6 release to test 83 File validation module C5.4 test data upload module 10 days 43 B3.1 create folders for errors and desktop validation 3 days C5.5 test integration 10 days 50 3 days 17 C5.6 prepare final test reports 62 B3.2 develop field data format base 2 days B3.3 develop code to test data against field data format base 3 days 18 C6 User Acceptance Testing B3.4 develop code for data progression to desktop validation C6.1 User training 1 day 62 folder 4 days C6.2 User test file pickup module 5 days B3.5 develop code for rejection actions days C6.3 User test file validation module 5 days 83.6 create error logs, errors and confirmation emails 3 days C6.4 User test desktop validation module 5 days B3.7 system test 6 days 6.5 User test data upload module day B3.8 release to test 0 days 6.6 prepare final user test reports 2 days B4 Desktop validation 7 Live data testing B4.1 create folders for errors and upload to BiiP records 3 days 8 C7.1 acceptance test end to end using live datas 3 days 58;59;60;61:62 B4.2 develop desktop review module C7.2 user test end to end using live data days 2;66;67;68;69;70 34.2.1 develop screens for view of data 4 days 8FS+1 day C7.3 prepare final test reports 2 days 63;70 $4.2.2 develop screens for view of attachments 6 days 28SS C7.4 prepare acceptance reports 2 days 74 B4.2.3 develop code to upload data for desktop validation 3 days 29SS C8 Testing complete 0 days 75 84.5 develop code to upload accepted data to Blip 4 days 28;29;30 D RELEASE TO PRODUCTION B4.6 develop code to send rejected data to error folder days 31SS D1 Release plan B4.7 create error logs, errors and confirmation emails 3 days 32 D1.1 final documentation for support team 3 days 51;76 B4.8 system test 10 days 31;32;33 D1.2 final documentation for user training 3 day 76 B4.9 Release to test 0 days 34 D1.3 Change Control Board 1 day 79;80 85 DATA UPLOAD TO BIIF D1.4 Schedule release 2 days 81 B5.1 create folders for errors and confirmations 3 days 8 D1.5 Release to production. 1 day 82 85.2 develop integration code to upload data to Blip 3 day 37 Project completed day 83 B5.3 develop code to flag failed uploaded data 2 days 38 B5.4 develop code to send failed data to error folder 3 days 39 B5.5 create error logs, errors and confirmation emails 5 days 40 85.6 system test 10 days 41Appendix 3 Resources and costs Resource Responsibilities Cost Internal/External Project Manager Manage project and deliver outcomes $150/ hr. External Development Manager Manage and coordinate development activities. Develop schedule of development activities $1100 / day Internal Developerx3 Development of code according to specified and agreed/approved requirements $900 / day External Test Manager Manage and coordinate testing activities. Develop schedule of testing activities Prepare final test acceptance and test management report for acceptance before hand over to production. $1100/ day Internal Testerx 5 Develop test scripts according to RTM. Prepare test data. Carry out tests according to test scripts using test data. Carry out tests according to test scripts using live data $1000/ day External Infrastructure Engineer Identify, confirm, and orchestrate infrastructure requirements, including: * SharePoint solution and setup. = Access for Client and Vendor teams + Access to Property Management Database for client team, testing team and development team (test environment) $300 / day Internal Quality Engineer Prepare guality metrics according to applicable quality standards. Prepare quality assurance approach. Prepare guality control tools against test outcomes. Manage quality audit. Track and implement quality improvements $1100/day Internal Appendix 4 SGD Reporting and Performance Measurement Standards Level of accuracy Project costs are reported in dollars to the nearest dollar. Durations are tracked and reported in days to the nearest day. 'Work is reported and estimated in hours based on 8-hour day and the daily rate for each external resource. Threshold - Schedule and Cost. This is a short project with a high impact and high importance. The threshold for schedule delay is limited to 5 days. Tasks will need to be tracked at task level and reported at task level. Where the task is delayed by less than 5 days, it remains within the scope of the Project Manager to resolve the delay. Where the task or the overall project is delayed by 5 or more days, it will be escalated to the Project Steering Committee for further action. Cost threshold is 10%. Where the actual running cost is up to 10% over the approved baseline budget, the Project Management is responsible for resolution and bringing the Cost back to baseline. Where the current cost is 10% over the approved baseline budget, the issue will escalate to the Project Steering Committee and Senior Management for decision. Reporting cycle Due to the duration of the project, the Steering Committee will meet weekly and will invite the Project Manager. The Project Manager will provide a status report demonstrating the status of the project deliverables and track costs against the approved baseline
Step by Step Solution
There are 3 Steps involved in it
Get step-by-step solutions from verified subject matter experts
