Question: I am trying to build out the ES/EF/LS/LF/Slack table for this chart. This is what I have, and I am confused on the LF and

I am trying to build out the ES/EF/LS/LF/Slack table for this chart. This is what I have, and I am confused on the LF and LS columns. Can someone check my work and tell me what I am doing wrong? I am calculating LS as LF-Duration, and EF as ES+Duration, and Slack as LF-EF. The only values I am filling in are ES and LF. The rest are calculated.
| Activity | Duration | ES | EF | LS | LF | Slack |
| A | 7 | 0 | 7 | -3 | 4 | -3 |
| B | 3 | 7 | 10 | 4 | 7 | -3 |
| C | 3 | 7 | 10 | 7 | 10 | 0 |
| D | 5 | 7 | 12 | 7 | 12 | 0 |
| E | 6 | 12 | 18 | 12 | 18 | 0 |
| F | 4 | 18 | 22 | 18 | 22 | 0 |
| G | 2 | 22 | 24 | 22 | 24 | 0 |
| H | 4 | 10 | 14 | 10 | 14 | 0 |
| I | 4 | 14 | 18 | 14 | 18 | 0 |
| J | 10 | 18 | 28 | 18 | 28 | 0 |
| K | 2 | 10 | 12 | 10 | 12 | 0 |
| L | 3 | 12 | 15 | 12 | 15 | 0 |
| M | 8 | 15 | 23 | 15 | 23 | 0 |
| N | 6 | 10 | 16 | 10 | 16 | 0 |
| O | 7 | 24 | 31 | 24 | 31 | 0 |
| P | 20 | 10 | 30 | 10 | 30 | 0 |
| Q | 4 | 10 | 14 | 16 | 20 | 6 |
| R | 4 | 14 | 18 | 20 | 24 | 6 |
| S | 3 | 25 | 28 | 25 | 28 | 0 |
| T | 4 | 7 | 11 | 7 | 11 | 0 |
| U | 6 | 11 | 17 | 11 | 17 | 0 |
| V | 7 | 11 | 18 | 11 | 18 | 0 |
| W | 4 | 18 | 22 | 18 | 22 | 0 |
| X | 8 | 17 | 25 | 17 | 25 | 0 |
| Y | 6 | 10 | 16 | 10 | 16 | 0 |
| Z | 6 | 16 | 22 | 16 | 22 | 0 |

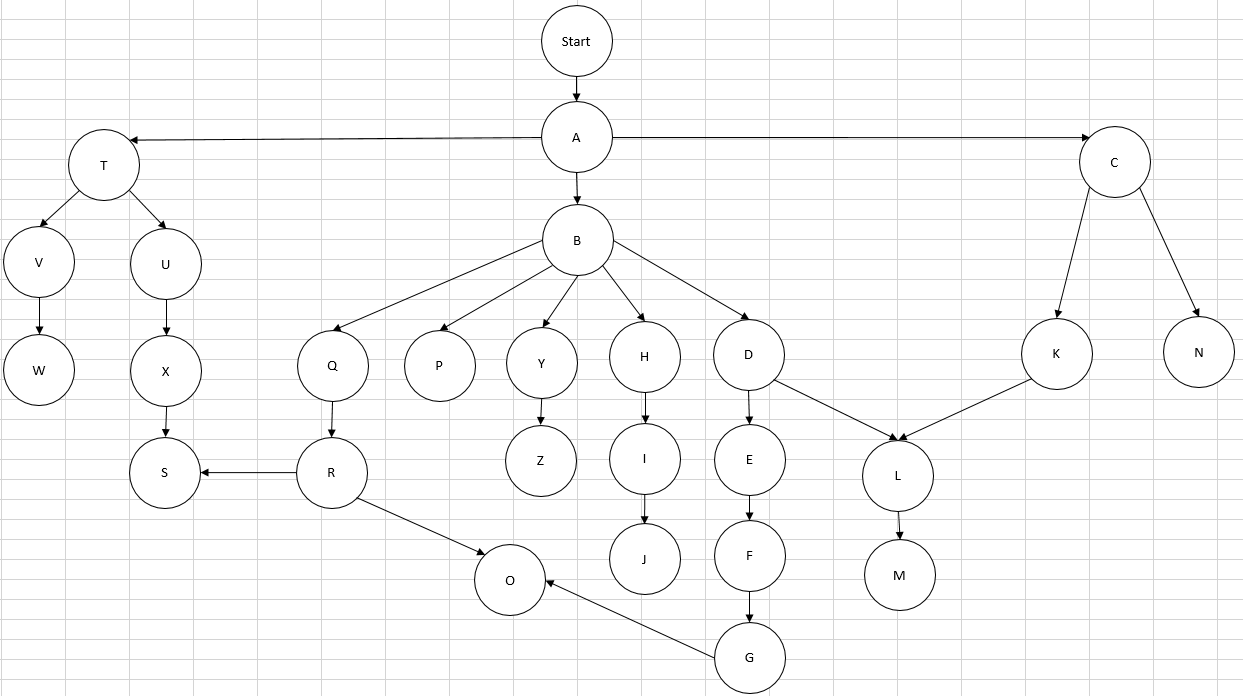

I've also included my chart that I drew based on the table.

After figuring out the table, I should be able to find the critical path.
Thank you

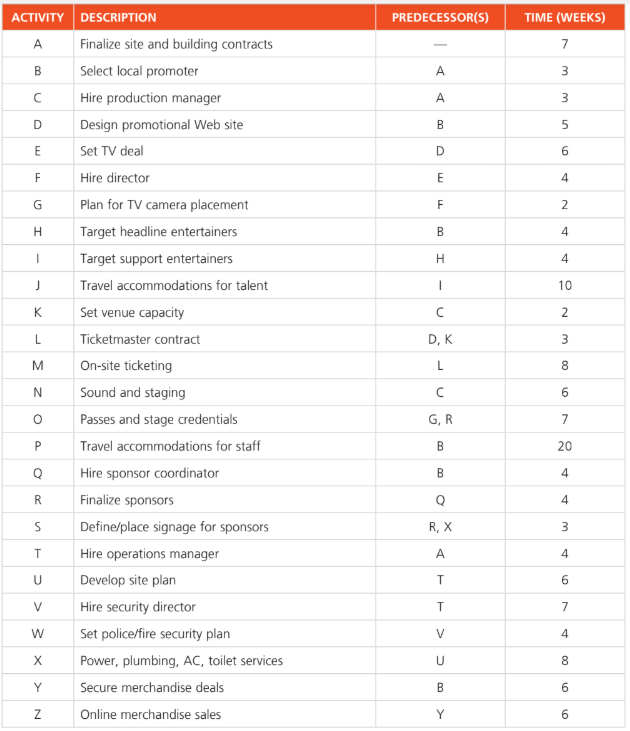

PREDECESSOR(S) TIME (WEEKS) 7 B A 3 n A 3 5 D B E D 6 F E 4 G F 2 H I 4 J 1 10 K 2 L DK 3 ACTIVITY DESCRIPTION A Finalize site and building contracts Select local promoter Hire production manager Design promotional Web site Set TV deal Hire director Plan for TV camera placement Target headline entertainers 1 Target support entertainers Travel accommodations for talent Set venue capacity Ticketmaster contract On-site ticketing Sound and staging Passes and stage credentials Travel accommodations for staff Q Hire sponsor coordinator Finalize sponsors Define/place signage for sponsors Hire operations Manager Develop site plan Hire security director Set police/fire security plan Power, plumbing, AC, toilet services Secure merchandise deals Z Online merchandise sales M L 8 N 6 o GR 7 B 20 Q B 4 R 4 S R, X 3 T A 4 U T 6 V T 7 w V 4 U 8 Y B 6 Y 6 Start A V U N w Q P X S R L MStep by Step Solution
