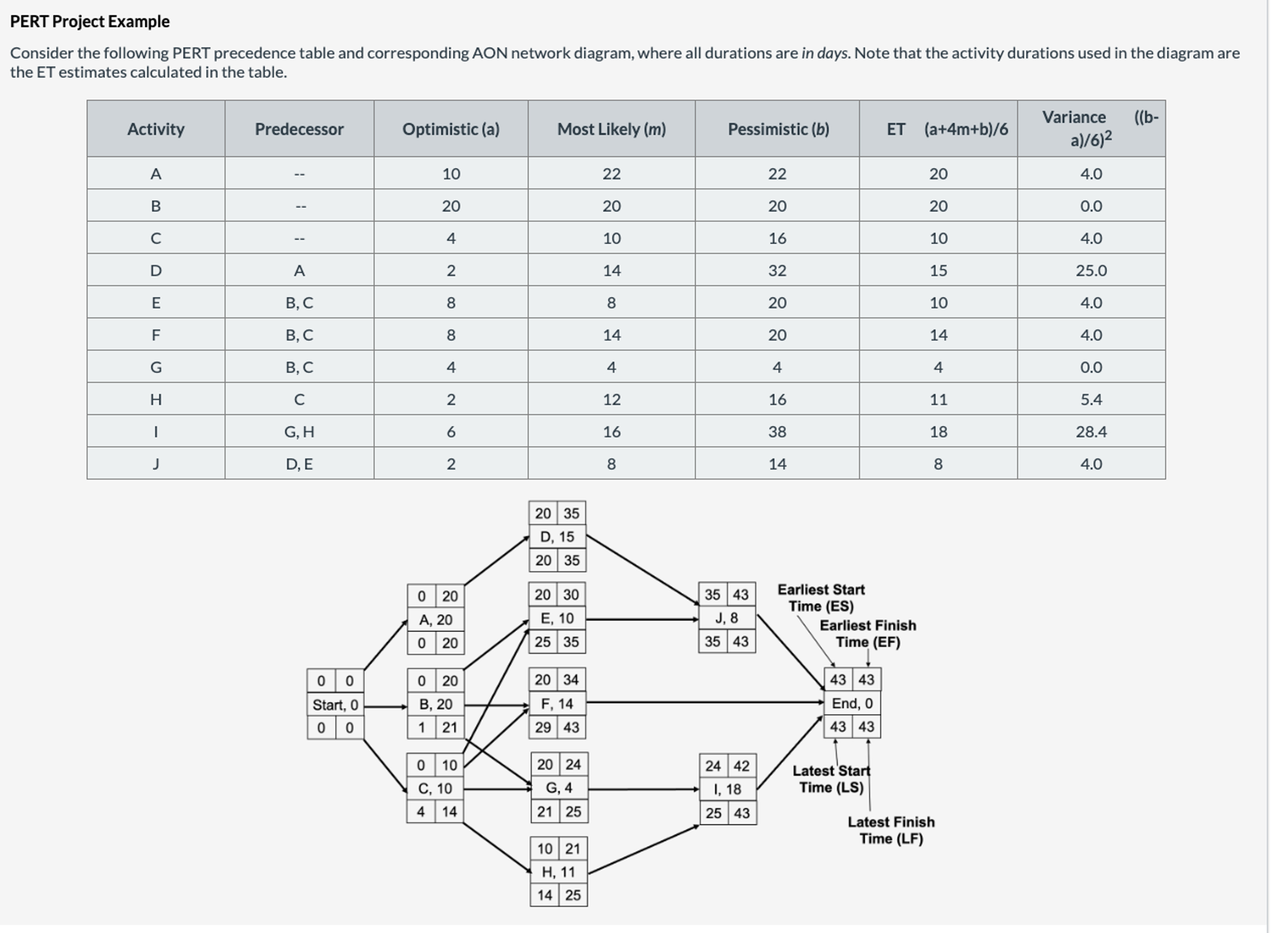

Question: PERT Project Example Consider the following PERT precedence table and corresponding AON network diagram, where all durations are in days. Note that the activity durations

PERT Project Example
Consider the following PERT precedence table and corresponding AON network diagram, where all durations are in days. Note that the activity durations used in the diagram are
the ET estimates calculated in the table.
 PERT Project Example Consider the following PERT precedence table and corresponding
