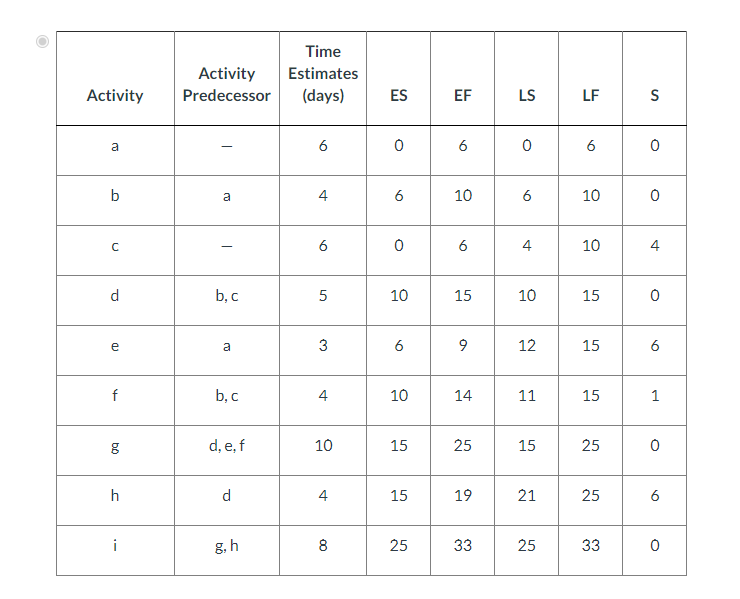

Question: Please A) identify the critical path and B) determine the project duration time. I already identified the network and it is posted. Lindsey Brinton is

Please A) identify the critical path and B) determine the project duration time. I already identified the network and it is posted.

Lindsey Brinton is moving into a rental house near campus at the beginning of the new fall semester at Tech with three friends. Each of the four friends will have a bedroom that they can redecorate as they wish. Lindsey wants to wallpaper her room and put down new carpet. She has identified the following activities and the times they will take that she will need to accomplish to complete the project before school starts: Identify the critical path and determine the project duration time. Critical path Project duration time eTextbook and Media
