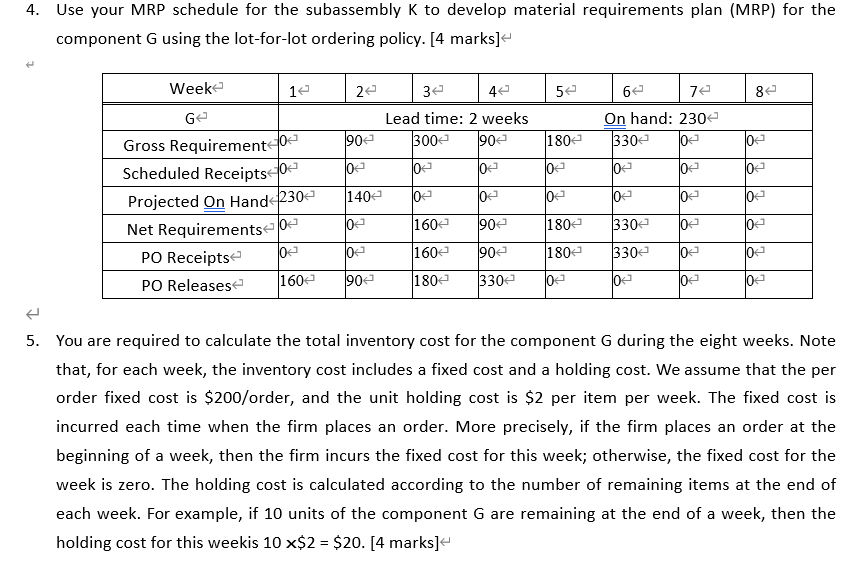

Question: PLEASE ANSWER Q.6 AND Q.7 4. Use your MRP schedule for the subassembly K to develop material requirements plan (MRP) for the component G using
PLEASE ANSWER Q.6 AND Q.7


Step by Step Solution
There are 3 Steps involved in it
1 Expert Approved Answer
Step: 1 Unlock
Question Has Been Solved by an Expert!
Get step-by-step solutions from verified subject matter experts
Step: 2 Unlock
Step: 3 Unlock
