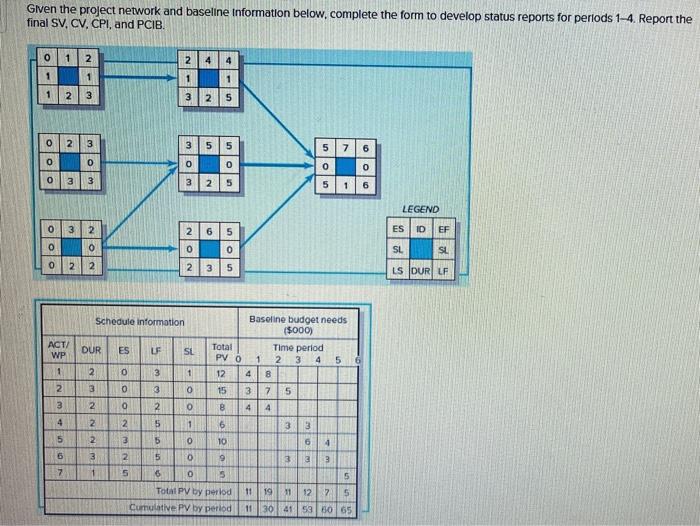

Question: Please help with only EAC and VAC; very last screenshot. Everything else is correct but my calculations on those isn't right. I dont know why!

Given the project network and baseline information below, complete the form to develop status reports for periods 14. Report the final SV, CV, CPI, and PCIB. (Do not round intermediate calculations. Enter all answers to 2 decimal places. For SPI, CPI, and PCI-B, enter your answers as decimals rather than percentage format (e.9., enter 0.93 Instead of 93\%).) Answer is complete and correct. Answer is complete and correct. Answer is complete and correct. End of feriod 4 x Answer is complete but not entirely correct
