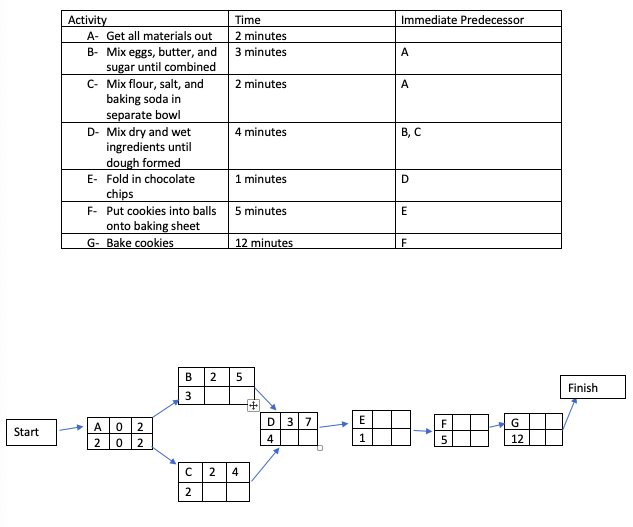

Question: Please solve with charts and critical path Immediate Predecessor Time 2 minutes 3 minutes A 2 minutes A Activity A- Get all materials out B-

Please solve with charts and critical path
Immediate Predecessor Time 2 minutes 3 minutes A 2 minutes A Activity A- Get all materials out B- Mix eggs, butter, and sugar until combined C- Mix flour, salt, and baking soda in separate bowl D- Mix dry and wet ingredients until dough formed E- Fold in chocolate chips F- Put cookies into balls onto baking sheet G- Bake cookies 4 minutes B, C 1 minutes D 5 minutes E 12 minutes F 5 B 2 3 Finish Start A 2 02 02 D37 4 E 1 F 5 12 4 C2 2Step by Step Solution
