Question: Plot the risks on a risk matrix Step 2: Plot the risks on a Risk Severity Matrix. Risk Likelihood Impact Severity Delays in Hiring Contractors

Plot the risks on a risk matrix

Plot the risks on a risk matrix Step 2: Plot the

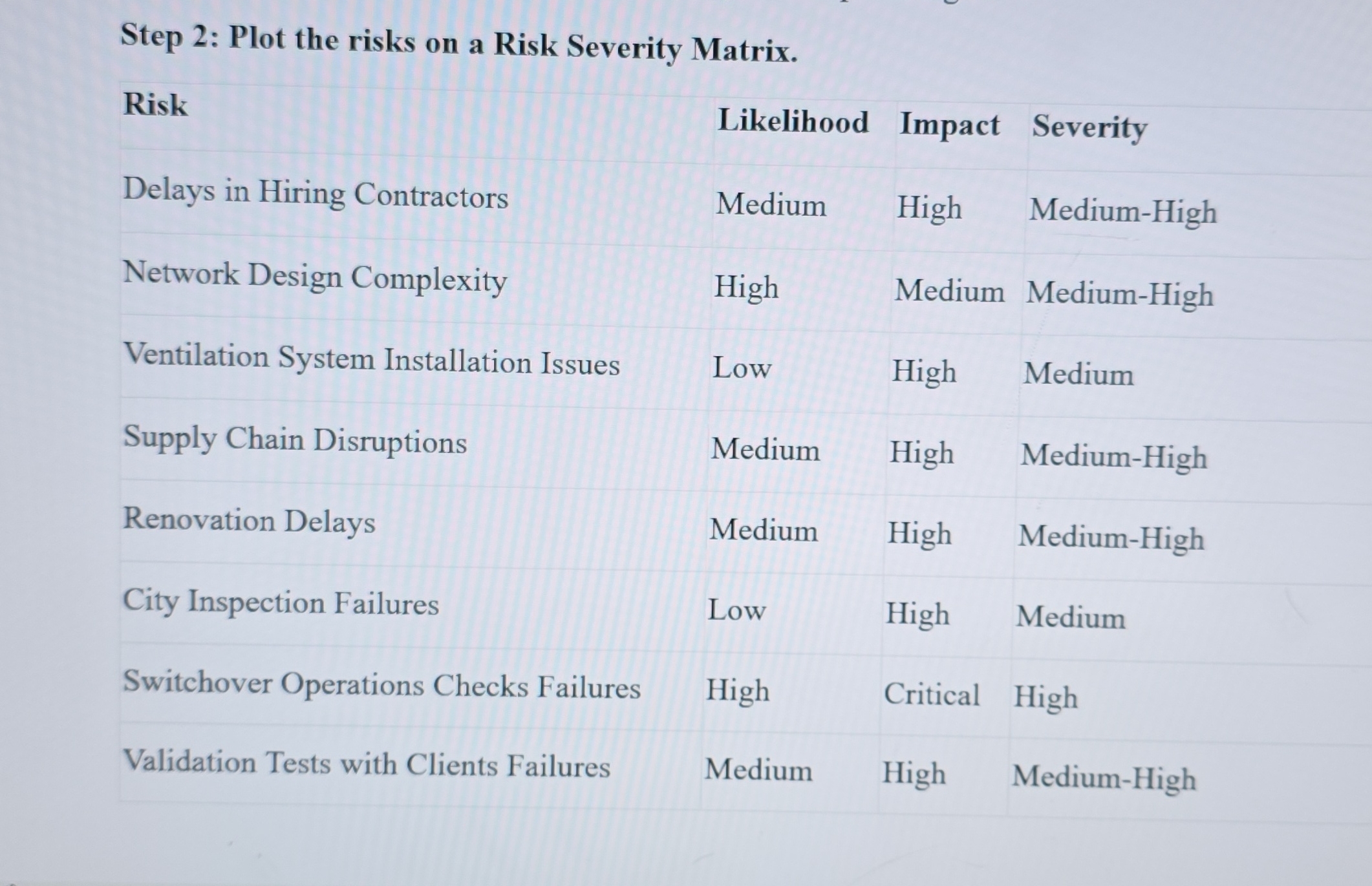

Step 2: Plot the risks on a Risk Severity Matrix. Risk Likelihood Impact Severity Delays in Hiring Contractors Medium High Medium-High Network Design Complexity High Medium Medium-High Ventilation System Installation Issues Low High Medium Supply Chain Disruptions Medium High Medium-High Renovation Delays Medium High Medium-High City Inspection Failures Low High Medium Switchover Operations Checks Failures High Critical High Validation Tests with Clients Failures Medium High Medium-High
