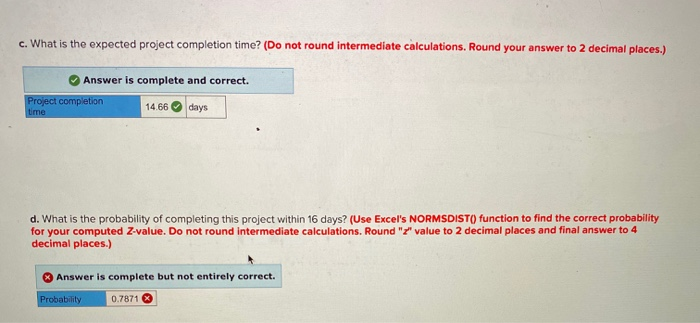

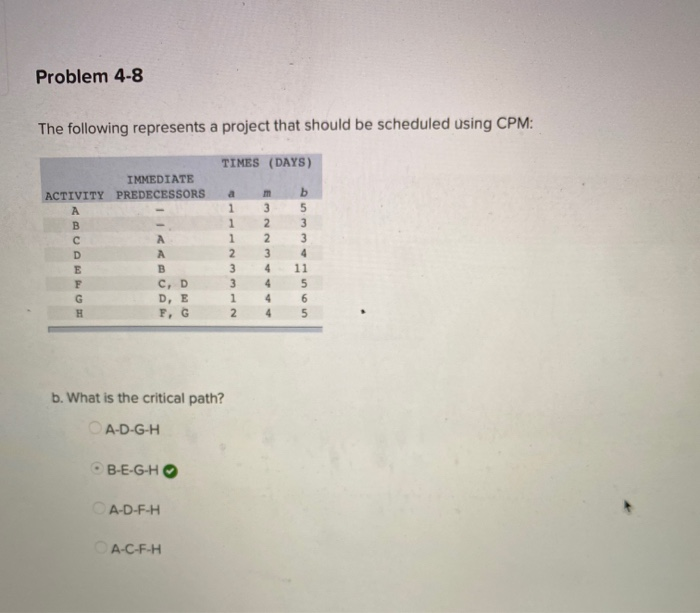

Question: Problem 4-8 The following represents a project that should be scheduled using CPM: TIMES (DAYS) IMMEDIATE ACTIVITY PREDECESSORS A B A D E B E
