Question: Problem 5-13 A construction project is broken down into the following 10 activities: c. If activities 1 and 10 cannot be shortened, but activities 2
Problem 5-13

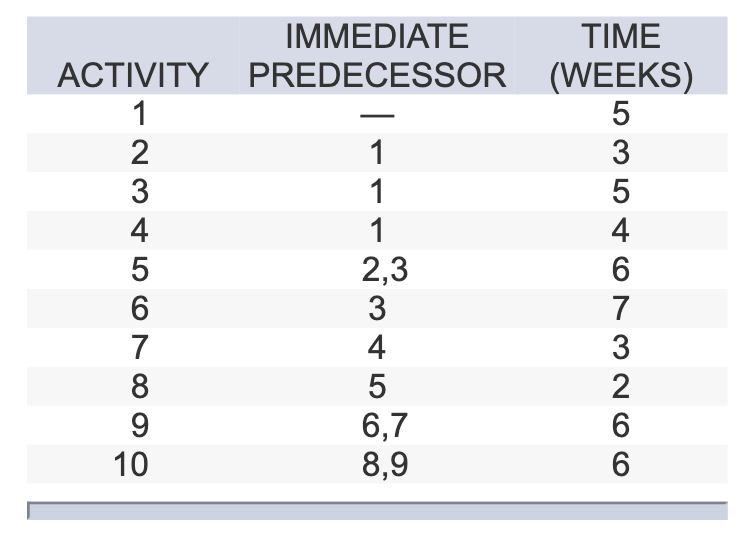

A construction project is broken down into the following 10 activities:

c. If activities 1 and 10 cannot be shortened, but activities 2 through 9 can be shortened to a minimum of one week each at a cost of $10,000 per week, which activities would you shorten to cut the project by four weeks? (You may select more than one answer. Single click the box with the question mark to produce a check mark for a correct answer and double click the box with the question mark to empty the box for a wrong answer.)
