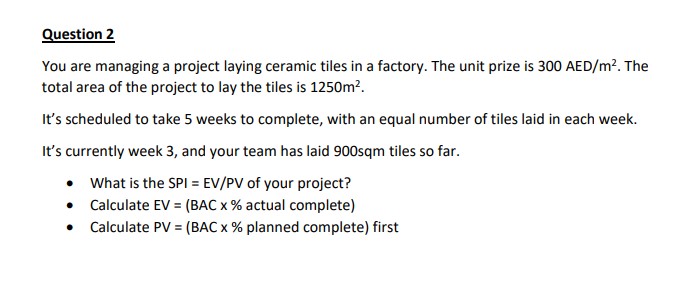

Question: Question 2 You are managing a project laying ceramic tiles in a factory. The unit prize is 300 AED/m2. The total area of the project

Question 2 You are managing a project laying

Question 2 You are managing a project laying ceramic tiles in a factory. The unit prize is 300 AED/m2. The total area of the project to lay the tiles is 1250m. It's scheduled to take 5 weeks to complete, with an equal number of tiles laid in each week. It's currently week 3, and your team has laid 900sqm tiles so far. What is the SPI = EV/PV of your project? Calculate EV = (BAC X % actual complete) Calculate PV = (BAC x % planned complete) first
