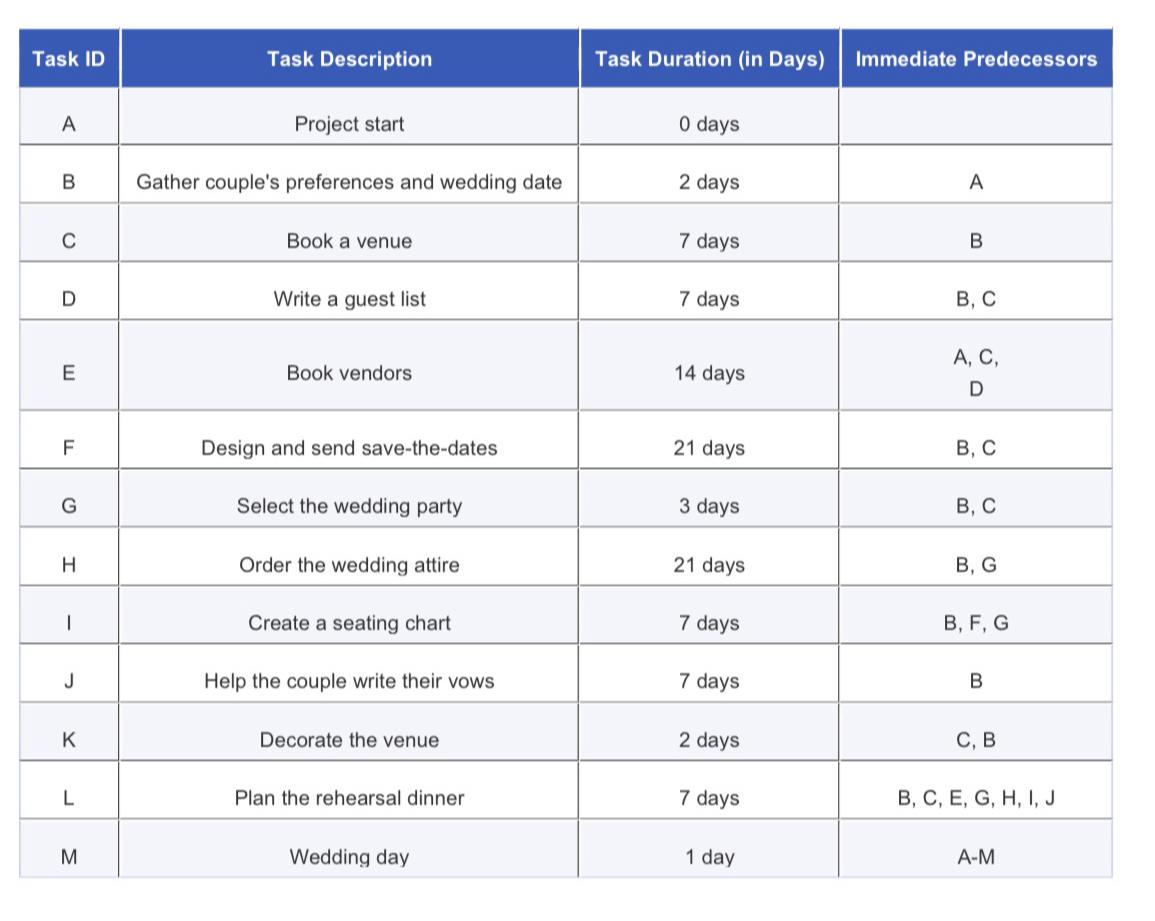

Question: table [ [ Task ID , Task Description,Task Duration ( in Days ) , Immediate Predecessors ] , [ A , Project start, 0

\table[[Task ID,Task Description,Task Duration (in Days),Immediate Predecessors],[A,Project start,0 days,],[B,Gather couple's preferences and wedding date,2 days,A],[C,Book a venue,7 days,B],[D,Write a guest list,7 days,B,C
 \table[[Task ID,Task Description,Task Duration (in Days),Immediate Predecessors],[A,Project start,0 days,],[B,Gather couple's preferences
