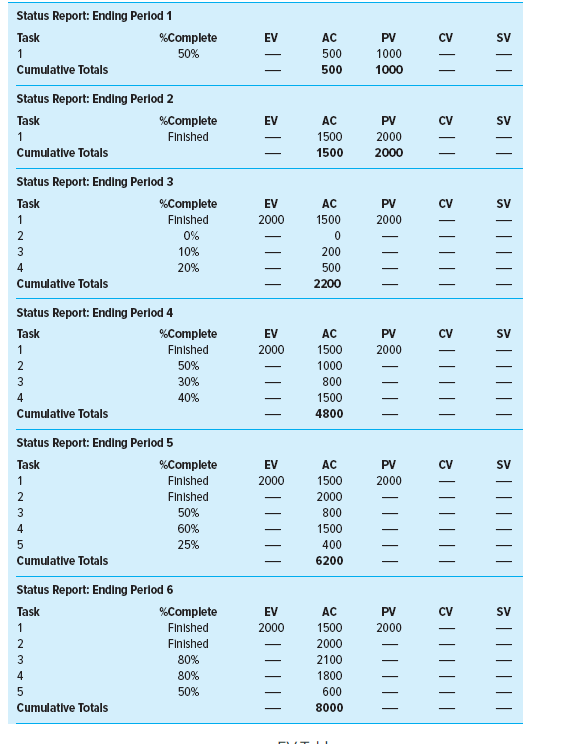

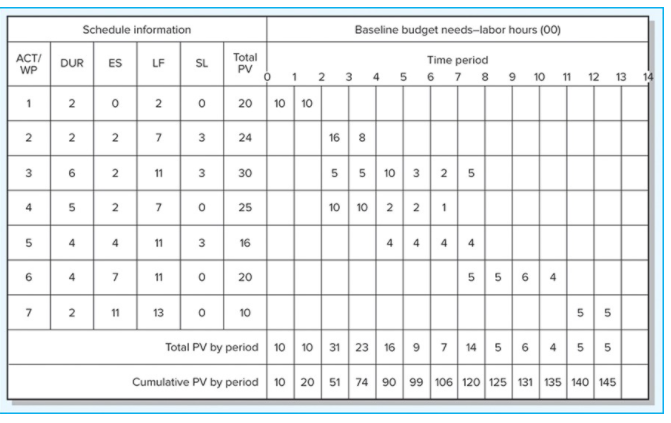

Question: The following labor hours data have been collected for a nanotechnology project for periods 1 through 6. Compute the SV, CV, SPI, and CPI for

The following labor hours data have been

The following labor hours data have been

The following labor hours data have been

The following labor hours data have been

The following labor hours data have been collected for a nanotechnology project for periods 1 through 6. Compute the SV, CV, SPI, and CPI for each period. Plot the EV and the AC on the summary graph provided (or a similar one). Plot the SPI, CPI, and PCIB on the index graph provided (or a similar one). What is your assessment of the project at the end of period 6 ? SPl=EV/PV CPI=EV/AC PCIB=EV/BAC
