Question: There is a technical mistake in the 6 th task. The duration of activity F should be 2 but I have mistakenly wrote there 1.

There is a technical mistake in the 6th task. The duration of activity F should be 2 but I have mistakenly wrote there 1. Please consider it.

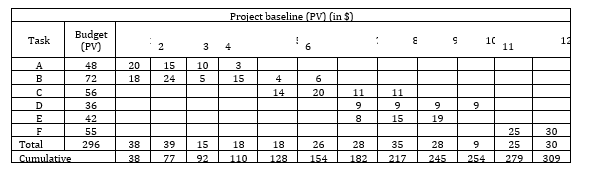

6. Given the following project network, baseline, and status information, develop status reports for periods 2, 4, 6, 8 and complete the performance indexes table. Calculate the EACE and the VACE. Based on your data, what is your assessment of the current status of the project? At completion? Also, please calculate the backward pass and find the slacks (5 points) 8 0 4 4 10 F 12 6 D 10 0 B B 6 1 6 6 E Project baseline (PV) (in $) Task Budget (PV) E 9 10 16 12 2 3 4 11 A B 20 18 15 24 10 5 3 15 4 6 20 14 11 48 72 56 36 42 55 296 11 9 15 9 9 19 D E F Total Cumulative 8 9 38 38 39 77 15 92 18 110 18 128 26 154 28 182 35 217 28 245 25 25 279 30 30 309 254 EV PV CV SV AC 15 17 32 | | | || EV PV CV SV AC 45 54 99 EV PV CV SV Status Report: Ending Period 2 Task % Complete A 75% B 50% Cumulative Totals Status Report: EndingPeriod 4 Task % Complete A 100% B 100% Cumulative Totals Status Report: Ending Period 6 Task % Complete A 100% B 100% 75% D 0% E 50% Cumulative Totals Status Report: Ending Period Task % Complete A 100% B 100% 100% D 33% E 100% Cumulative Totals |||||| AC 33 44 34 0 20 131 III EV PV CV SV |||||| AC 45 24 37 15 20 141 EV AC PV SPI CPI PCI-B Period 2 4 6 8 II EACE VACStep by Step Solution
There are 3 Steps involved in it
Get step-by-step solutions from verified subject matter experts
