Question: Theyre all based off the data in the table so technically theyre all the same question What is the slack time of such activity (the

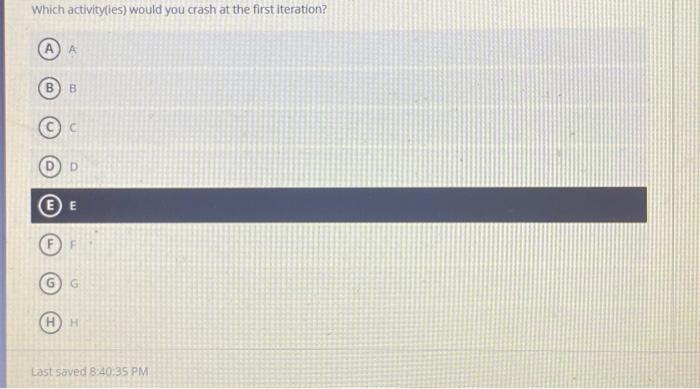

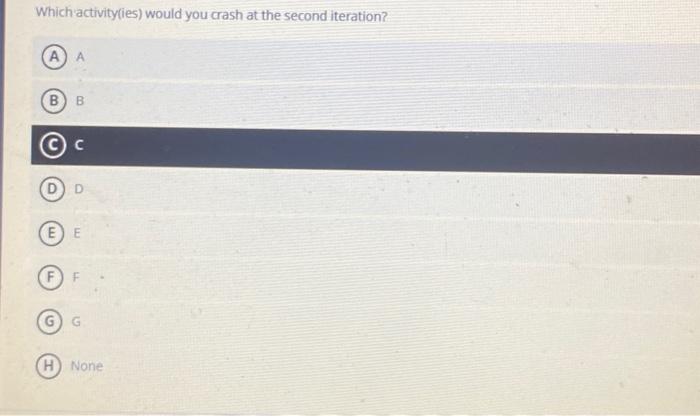

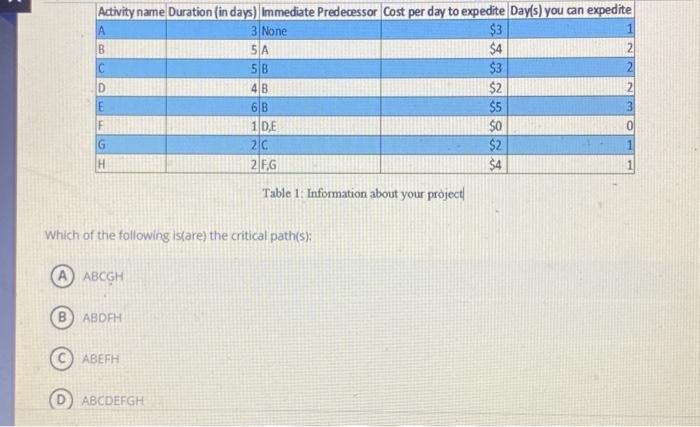

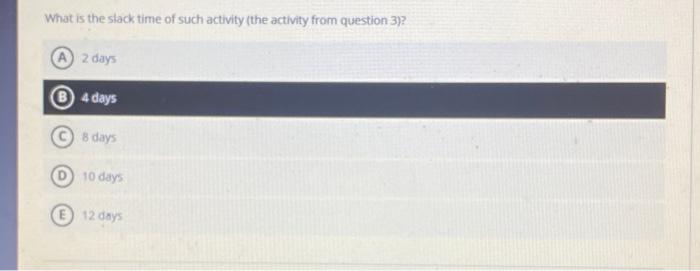

What is the slack time of such activity (the activity from question 3)? 2 days 4 days 8 days 10 days 12 doys What is the project completion time? 14 15 17 19 20 You have figured out your critical path and wish to expedite project by crashing activities. You have information in Table 1. You crash iteratively until you reach a point when crashing cannot improve your project completion time. For the first iteration, which of the following activities is not ideal for crashing and will not make any change to your completion time? Table 1: Information about your project Which of the following is(are) the critical path(s): ABCGH ABDFH ABEFH (D) ABCDEFGH Identify the activity with slack A B. c. D E F. G. H Which activity(ies) would you crash at the second iteration? A B C (D) D (E) E F G None Which activity(ies) would you crash at the first iteration? A. B c D E F G H
Step by Step Solution
There are 3 Steps involved in it
Get step-by-step solutions from verified subject matter experts
