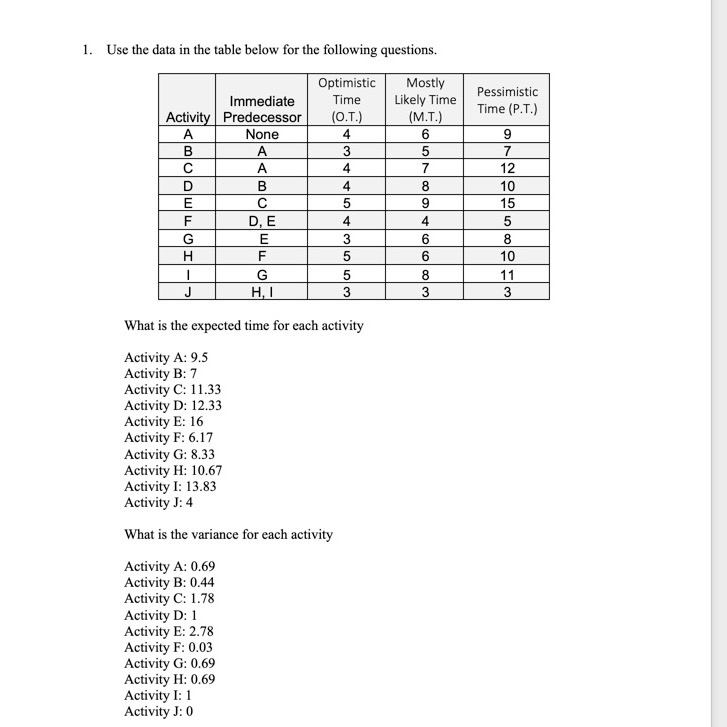

Question: Use the data in the table below for the following questions. What is the expected time for each activity Activity A: 9 . 5 Activity

Use the data in the table below for the following questions.
What is the expected time for each activity
Activity A: 9.5
Activity B: 7
Activity C: 11.33
Activity D: 12.33
Activity E: 16
Activity F: 6.17
Activity G: 8.33
Activity H: 10.67
Activity I: 13.83
Activity J: 4
What is the variance for each activity
Activity A: 0.69
Activity B: 0.44
Activity C: 1.78
Activity D: 1
Activity E: 2.78
Activity F: 0.03
Activity G: 0.69
Activity H: 0.69
Activity I: 1
Activity J: 0
1. What is the expected project completion time using the longest path method and the ES/EF;LS/LF method
2. What are the critical activities using the longest path method and the ES/EF; LS/LF method.
3. What are the slack values for non-critical activities using the longest path method and the ES/EF; LS/LF method
4. What is the probability that the project will be completed in 39 weeks using the longest path method and the ES/EF; LS/LF method
5. What is the probability that the project will be completed in 41 weeks using the longest path method and the ES/EF; LS/LF method
 Use the data in the table below for the following questions.

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
