Question: Using schedule performance index (SPI) and cost performance index (CPI), is the project ahead or behind budget and schedule? EARNED VALUE ANALYSIS DATA End of
Using schedule performance index (SPI) and cost performance index (CPI), is the project ahead or behind budget and schedule?

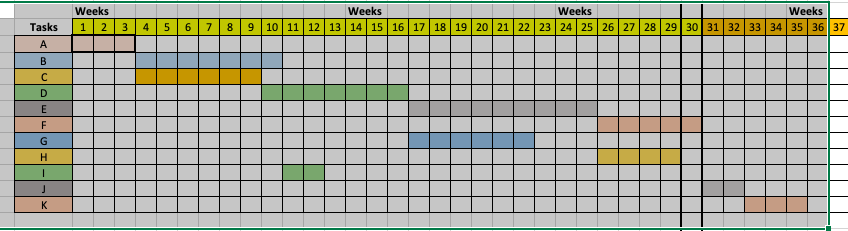

| EARNED VALUE ANALYSIS DATA | ||||
| End of Week 30 | ||||
| Task | Description | Estimated Activity Cost | Actual Expenses | Status Report % Complete |
| A | Requirements | $ 10,000 | $ 12,424 | 100% |
| B | Market Assesment | $ 20,000 | $ 20,157 | 100% |
| C | Design | $ 15,000 | $ 26,369 | 100% |
| D | Development | $ 45,000 | $ 63,797 | 100% |
| E | Testing | $ 10,000 | $ 11,012 | 100% |
| F | Revisions | $ 15,000 | $ 9,025 | 40% |
| G | Documentation | $ 20,000 | $ 19,819 | 100% |
| H | Quality Assurance | $ 10,000 | $ 14,483 | 80% |
| I | Pricing | $ 5,000 | $ 6,521 | 100% |
| J | Production | $ 40,000 | $ - | 0% |
| K | Distribution | $ 15,000 | $ - | 0% |
