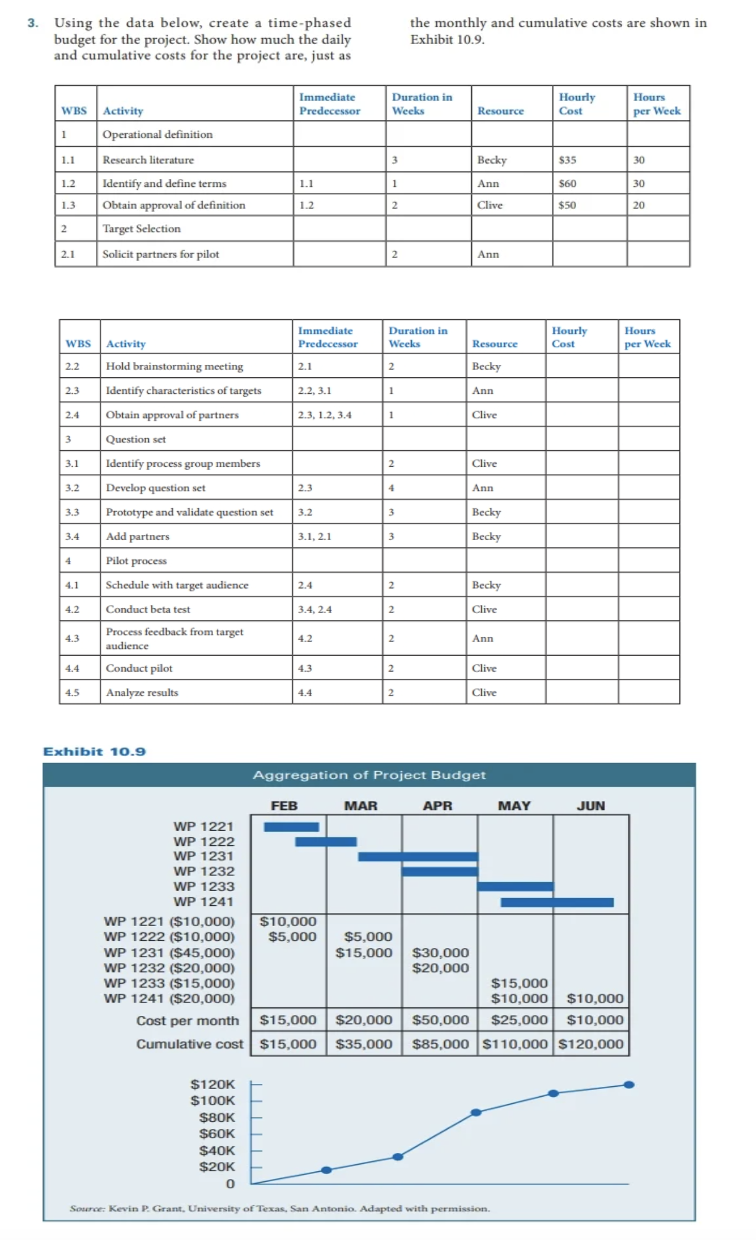

Question: Using the data below, create a time - phased budget for the project. Show how much the daily and cumulative costs for the project are,
Using the data below, create a timephased
budget for the project. Show how much the daily
and cumulative costs for the project are, just as
the monthly and cumulative costs are shown in
Exhibit
Exhibit
Aggregation of Project Budget
FEB
MAR APR
MAY JUN
Source: Kevin R Grant, University of Texas, San Antonio. Adapted with permission.
