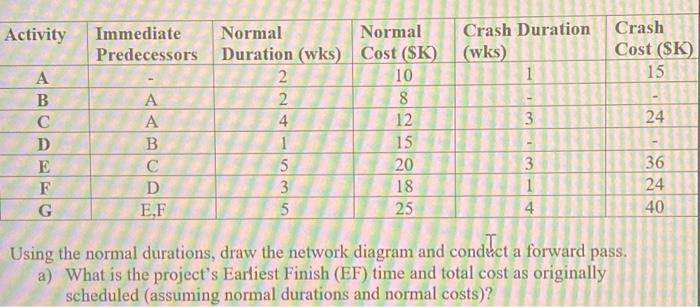

Question: Using the normal durations, draw the network diagram and conduct a forward pass. a) What is the project's Earliest Finish (EF) time and total cost

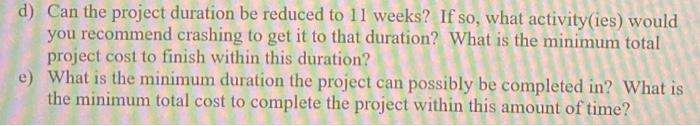

Using the normal durations, draw the network diagram and conduct a forward pass. a) What is the project's Earliest Finish (EF) time and total cost as originally scheduled (assuming normal durations and normal costs)? d) Can the project duration be reduced to 11 weeks? If so, what activity(ies) would you recommend crashing to get it to that duration? What is the minimum total project cost to finish within this duration? e) What is the minimum duration the project can possibly be completed in? What is the minimum total cost to complete the project within this amount of time
