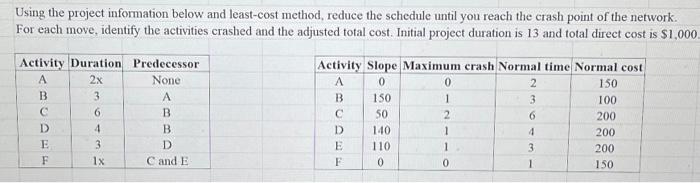

Question: Using the project information below and least-cost method, reduce the schedule until you reach the crash point of the network. For each move, identify the

Using the project information below and least-cost method, reduce the schedule until you reach the crash point of the network. For each move, identify the activities crashed and the adjusted total cost. Initial project duration is 13 and total direct cost is $1,000
