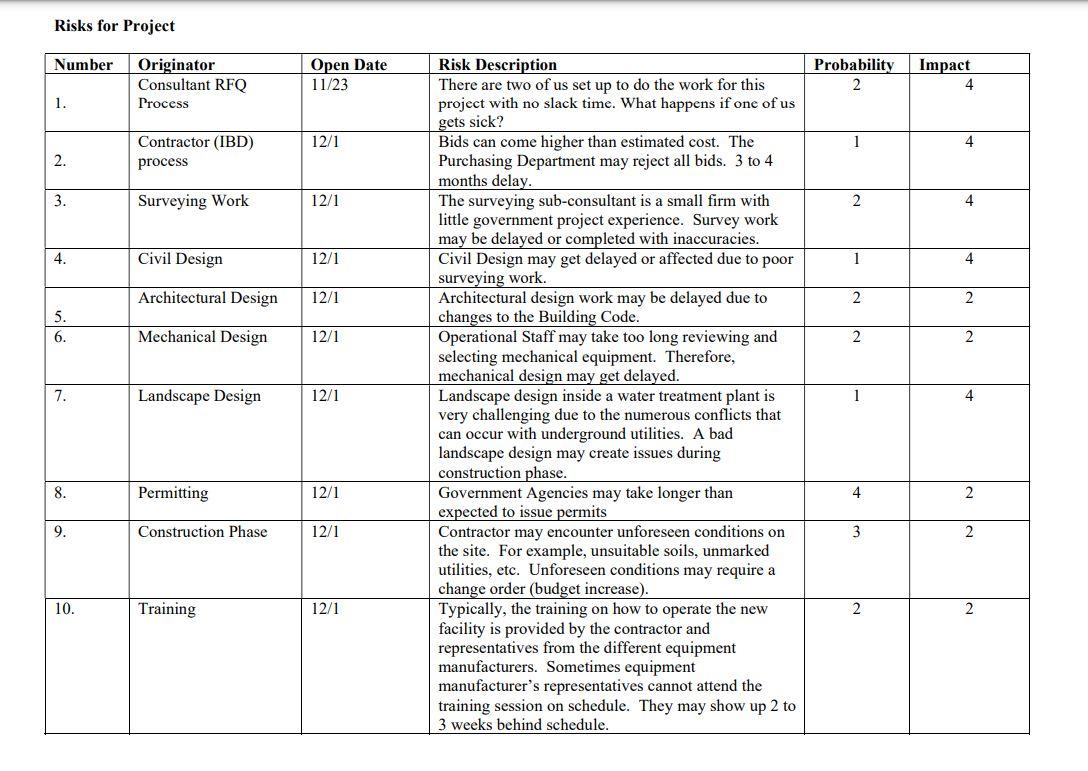

Question: Using the risks identified in the attached Risk Register document and the Risk Management Criteria document, enter every risk in the matrix by its probability

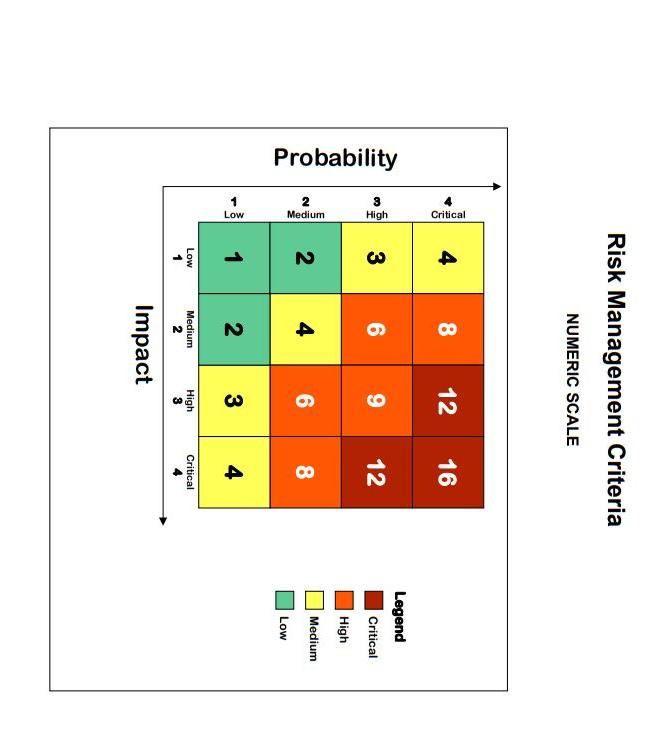

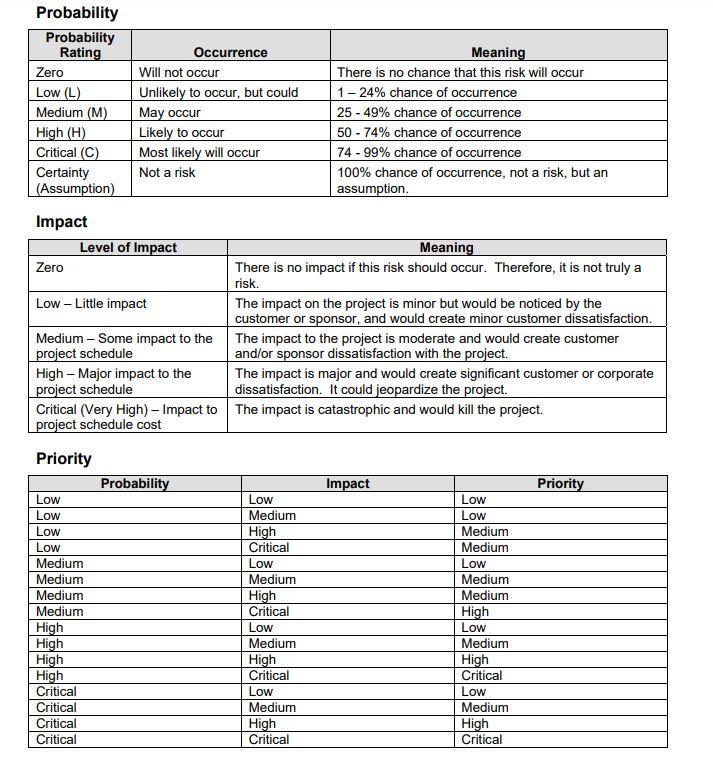

Using the risks identified in the attached "Risk Register" document and the "Risk Management Criteria" document, enter every risk in the matrix by its probability and impact. The position in the matrix correlates to the relative importance or, respectively, the risk level of the risk. Therefore, rank the risks from higher priority to lower priority based on the correlation between probability and impact.



Risks for Proiect Probability Impact Priority Risk Management Criteria NUMERIC SCALE
