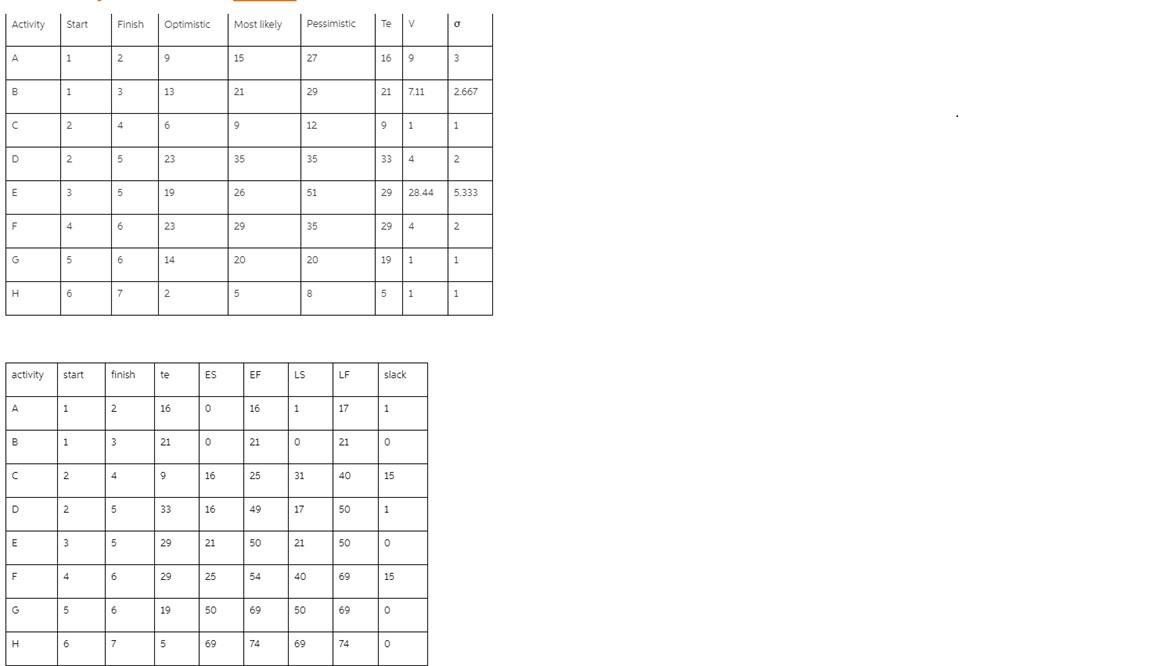

Question: What is the critical path for this project network? What is the estimated standard deviation for the CRITICAL PATH completion time? What is the probability
What is the critical path for this project network?
What is the estimated standard deviation for the CRITICAL PATH completion time?
What is the probability that the critical path for this project will be completed within 75 days? 80 days? 85 days? 90 days?
