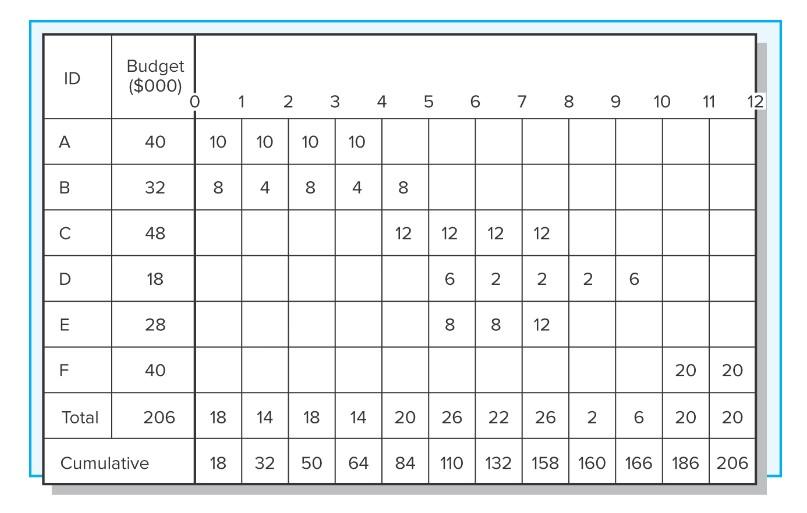

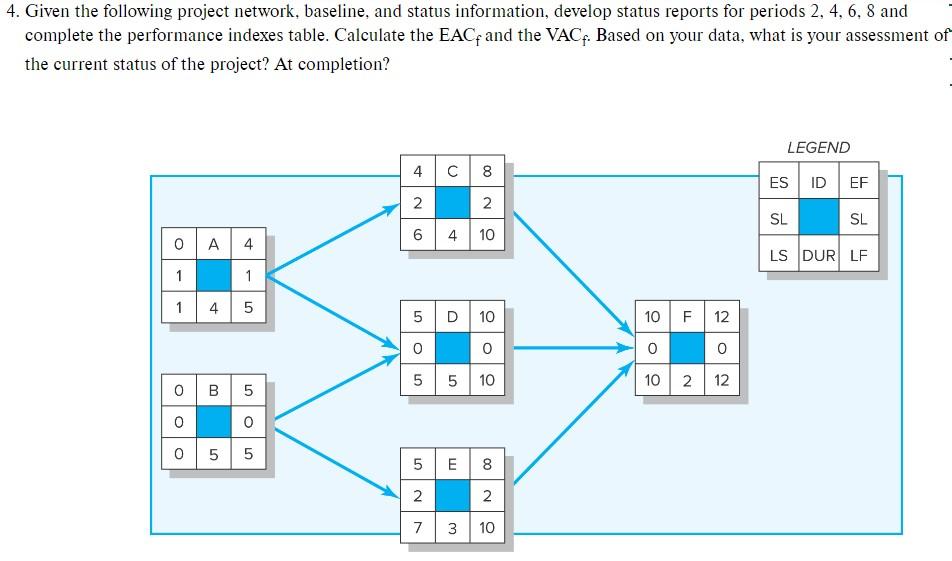

4. Given the following project network, baseline, and status information, develop status reports for periods 2,4,6,8 and complete the performance indexes table. Calculate the EACf and the VACf. Based on your data, what is your assessment of the current status of the project? At completion? Status Report: Ending Period 6 (\$000) Performance Indexes Summary Period246EVACPVSPICPIPCIB EACf=VACf=
