Question: [ 1 0 ] Determine the minimum cost increase to reduce the project duration by 3 days. table [ [ Activity , table

[10] Determine the minimum cost increase to reduce the project duration by 3 days.

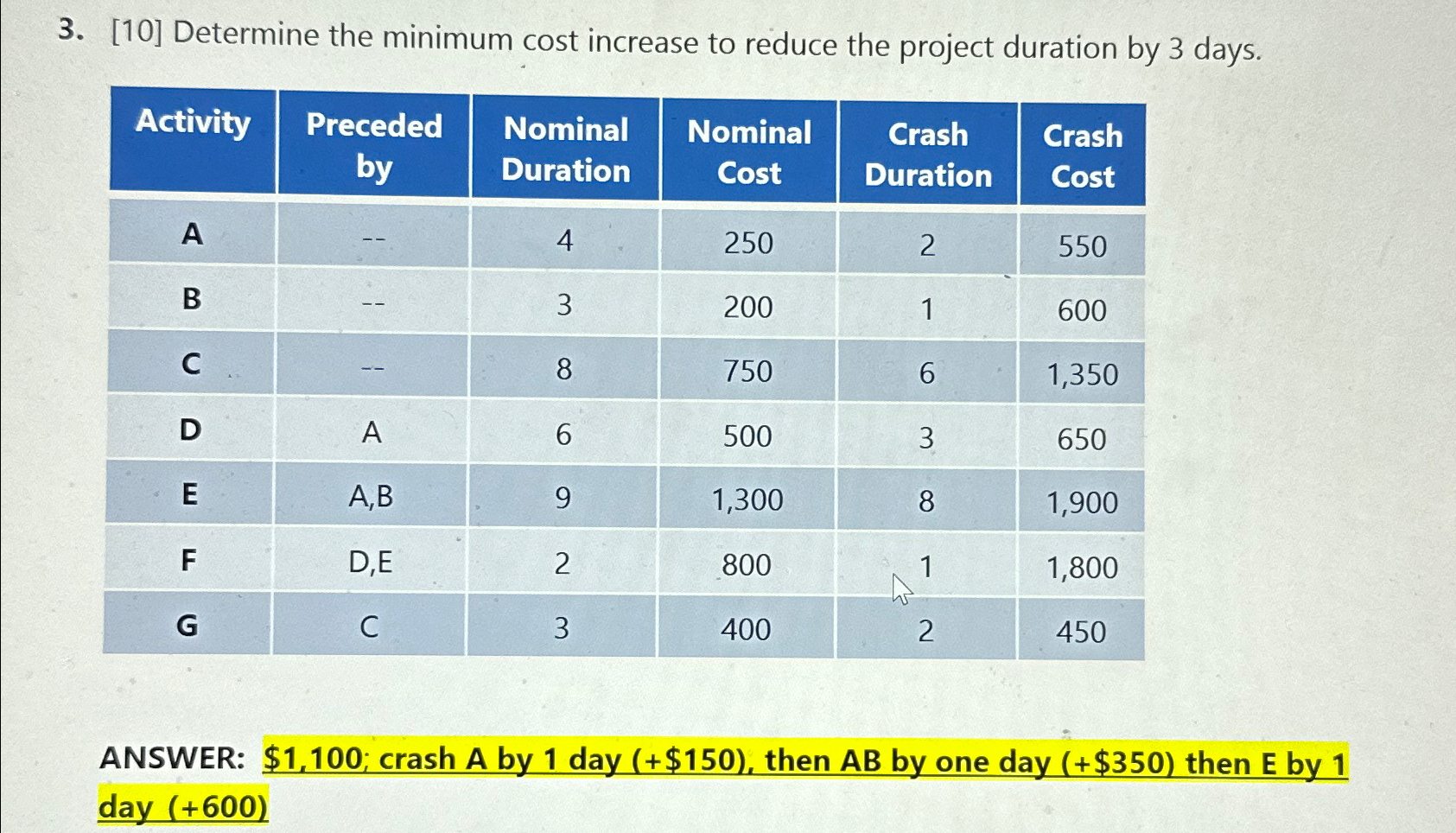

\table[[Activity,\table[[Preceded],[by]],\table[[Nominal],[Duration]],\table[[Nominal],[Cost]],\table[[Crash],[Duration]],\table[[Crash],[Cost]]],[A,--,4,250,2,550],[B,--,3,200,1,600],[C,--,8,750,6,1,350],[D,A,6,500,3,650],[E,A,B,9,1,300,8,1,900],[F,D,E,2,800,1,1,800],[G,C,3,400,2,450]]
ANSWER: $1,100; crash A by 1 day (+$150), then AB by one day (+350) then E by 1 day (+600)
