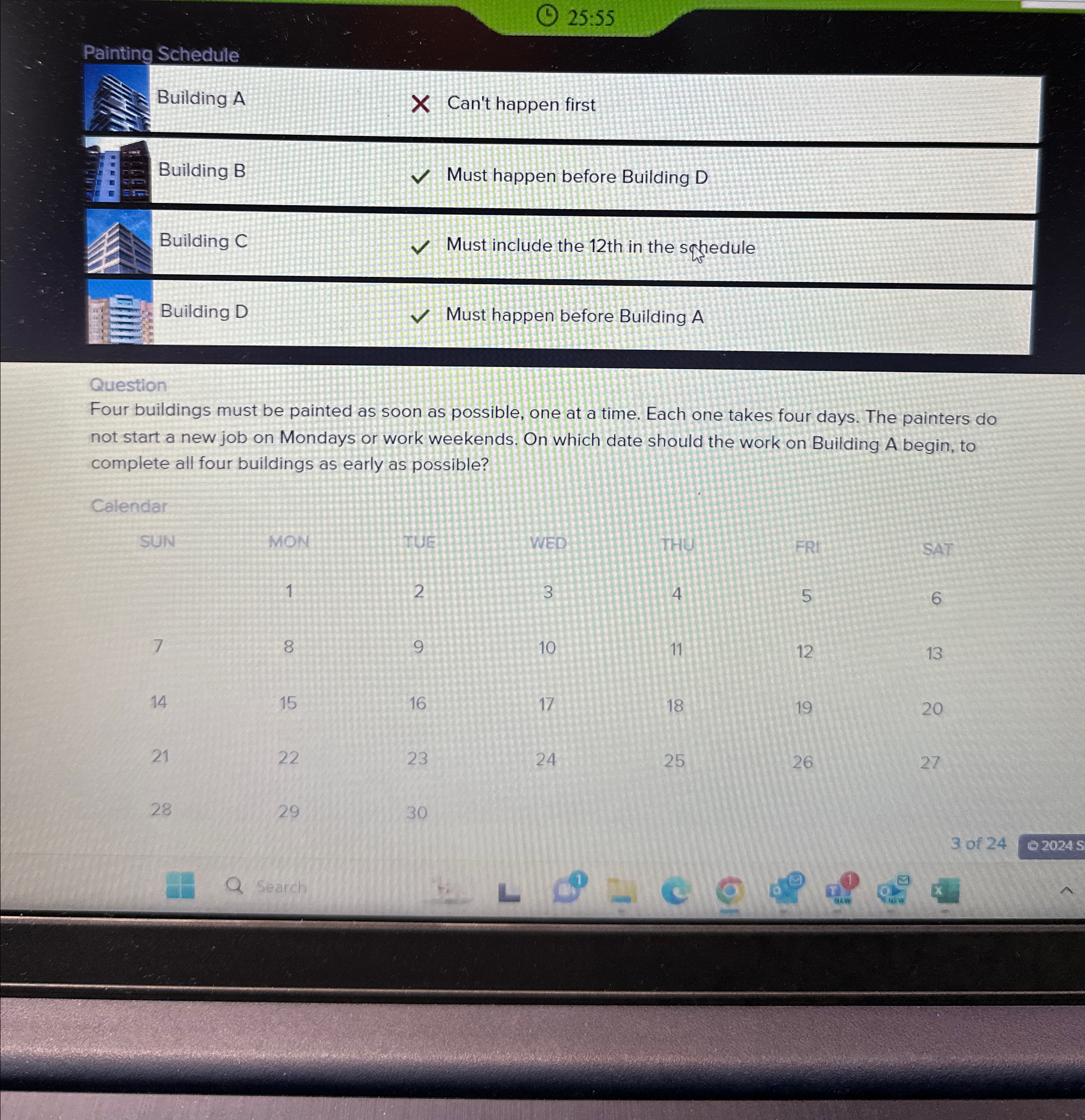

Question: ( 1 ) 2 5 : 5 5 Painting Schedule Building A Can't happen first Building B Must happen before Building D Building C Must
:
Painting Schedule
Building A
Can't happen first
Building B
Must happen before Building D
Building
Must include the th in the sqhedule
Building D
Must happen before Building A
Question
Four buildings must be painted as soon as possible, one at a time. Each one takes four days. The painters do not start a new job on Mondays or work weekends. On which date should the work on Building A begin, to complete all four buildings as early as possible?
