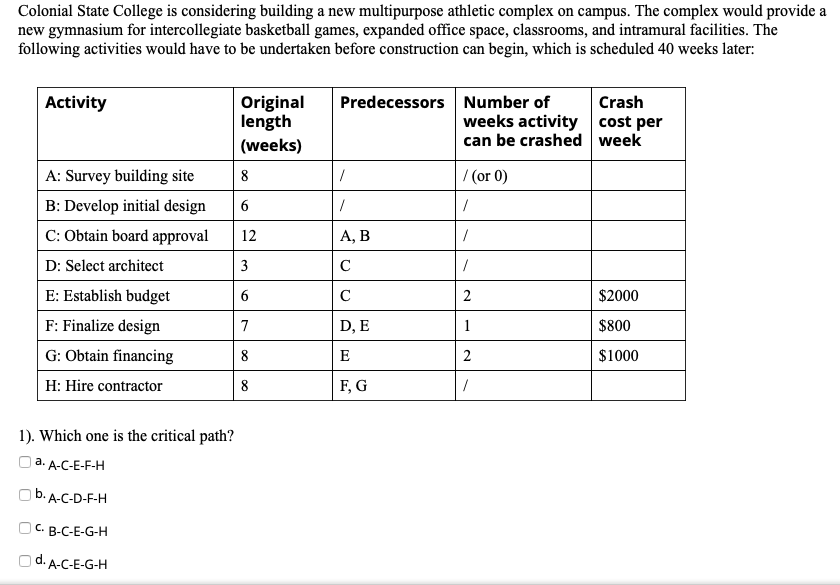

Question: 2. Can the project be completed before construction can begin, which is scheduled 40 weeks later? a. Yes, because the project duration time is 39

2.
Can the project be completed before construction can begin, which is scheduled 40 weeks later?
| a. | Yes, because the project duration time is 39 weeks. | |
| b. | No, because the project duration time is 41 weeks. | |
| c. | No, because the project duration time is 42 weeks. | |
| d. | Yes, because the project duration time is 40 weeks. |
3.
Which activities can be delayed without delaying the projection completion time?
| a. | B, D and F | |
| b. | B, D and G | |
| c. | A, D and G | |
| d. | A, D and F |
4.
To meet the 40-week construction deadline, what activities the manager should crash if necessary? What is the cost?
| a. | Crash E and G by 1 week respectively at a total cost of $3000. | |
| b. | There is no need to crash because it is meeting the deadline. | |
| c. | Crash E by 2 weeks at a cost of $4000. | |
| d. | Crash F by 1 week and G by 2 weeks respectively at a total cost of $2800. | |
| e. | Crash F by 1 week at a cost of $800. |
