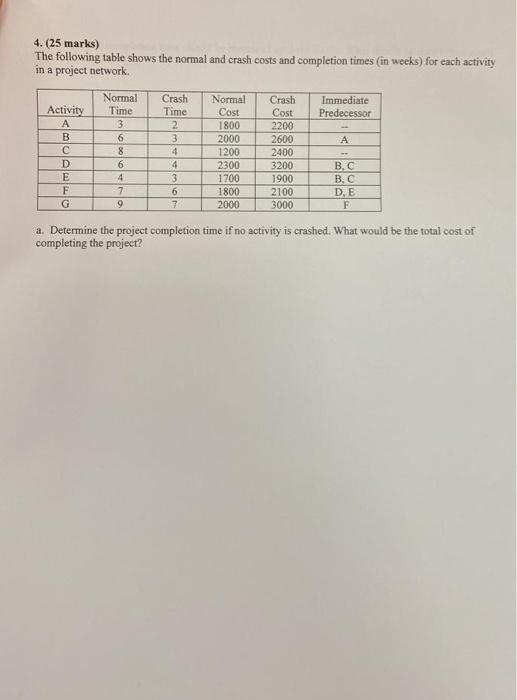

Question: 4. (25 marks) The following table shows the normal and crash costs and completion times (in weeks) for each activity in a project network. a.

4. (25 marks) The following table shows the
4. (25 marks) The following table shows the

4. (25 marks) The following table shows the normal and crash costs and completion times (in weeks) for each activity in a project network. a. Determine the project completion time if no activity is crashed. What would be the total cost of completing the project? b. Using the rule lot size=Multiple of 40 , determine the planned order releases for each week in the following MRP record. The lead time is 2 weeks
