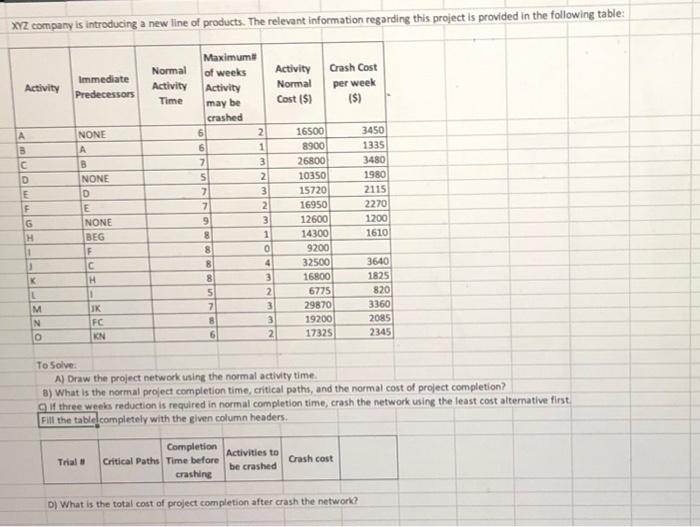

Question: A) Draw the project network using the normal activity time. 8) What is the normal project completion time, critical paths, and the normal cost of
A) Draw the project network using the normal activity time. 8) What is the normal project completion time, critical paths, and the normal cost of project completion? Q If three weeks reduction is required in normal completion time, crash the network using the least cost alternative first Fill the table completely with the given column headers. D) What is the total cost of project completion after crash the network
