Question: a. What would be your target completion week? b. How much would you save in total project costs with your schedule? You are the project
a. What would be your target completion week?
b. How much would you save in total project costs with your schedule?

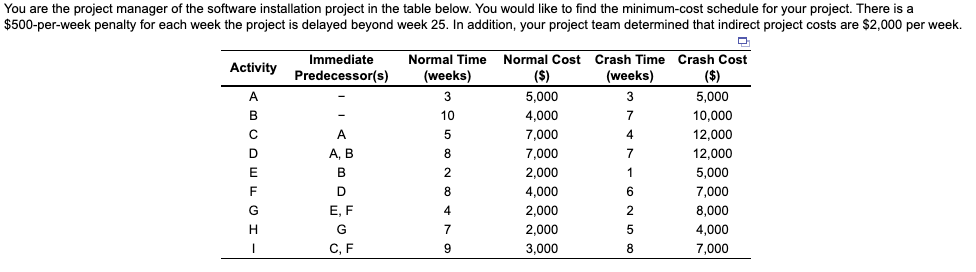

You are the project manager of the software installation project in the table below. You would like to find the minimum-cost schedule for your project. There is a $500-per-week penalty for each week the project is delayed beyond week 25. In addition, your project team determined that indirect project costs are $2,000 per week. Activity Immediate Predecessor(s) A B D E Normal Time (weeks) 3 10 5 8 Normal Cost Crash Time Crash Cost ($) (weeks) ($) 5,000 3 5,000 4,000 7 10,000 7,000 4 12,000 7,000 7 12,000 2,000 1 5,000 4,000 6 7,000 2,000 2 8,000 2,000 5 4,000 3,000 8 7,000 2 A A, B B D E, F G CF F 8 G 4 H 1 7 9Step by Step Solution
