Question: Assignment 2: Project Risk Management & Contingency Determination Overview: Sydney Metro project details as per Assignment 1. As part of the risk management team of

Assignment 2: Project Risk Management & Contingency Determination

Overview:

Sydney Metro project details as per Assignment 1. As part of the risk management team of XYZ Contractor, you are supporting the submission for a Design and Construct (D&C) Contract. You should undertake the required risk management and assessment activities for determination of the required cost and schedule contingency allowance for the defined scope of project below from a D&C contractor's perspective. You are required to research and find more details of this major project in order to successfully complete the assignment.

Option A: Victoria Cross Station

Details:

  • 31m below groundlevel
  • Construction at the station includes excavating two shafts, one will be used for future station entry and vertical access and the second shaft will become a future servicefacility.
    • Shaft 1: $10m (-20%, +50%), 2 month (-10%,+100%)
    • Shaft 2: $5m (-20%, +50%), 1 month (-10%,+100%)
    • Excavation of shaft 2 will commence after completion of shaft1.
  • 3 properties around the station need to be acquired in 6months.
    • Property 1: $5m (-10%,+30%)
    • Property 2: $2m (-5%,+20%)
    • Property 3: $3m (-5%,+25%)
    • If one owner can negotiate a higher price, the other owners will likely raise the prices too and viceversa.
    • It's expected the acquisition of these properties will be completed prior toconstruction.
  • Otherconcerns:
    • Underground services (2 months delay and $2m-$3m-$8mcost)
    • 2 months delay in completion ofacquisitions
    • Wet weather and increase in non-working days, more than 30mm/day rain will cause 3 days non-working day duringexcavationOption
    • B:Barangaroo Station

Details:

  • 25m below groundlevel
  • The construction site is usedfor:
    • Launching the TBM under Sydney Harbour to the BluesPoint
    • Retrieving the cutter heads and shields of the two tunnel boring machines that tunnel from the Marrickville divesite
    • Excavation and construction of the future BarangarooStation
    • Shaft 1: $20m (-20%, +50%), 6 month (-10%,+100%)
  • 2 properties around the station need to be acquired in 8months.
    • Property 1: $10m (-10%,+30%)
    • Property 2: $5m (-5%,+20%)
    • If one owner can negotiate a higher price, the other owner will likely raise the prices too and vice versa. No relationship between these properties and other properties at the Victoria Cross Station wasidentified.
    • It's expected the acquisition of these properties will be completed prior toconstruction.
  • Otherconcerns:
    • Underground services (2 months delay and $1m-$2m-$6mcost)
    • 3 months delay in completion ofacquisitions
    • 2 months delay in launching theTBM
    • Wet weather and increase in non-working days, more than 30mm/day rain will cause 3 days non-working day duringexcavation

Option C:Tunnels between two stations

Details:

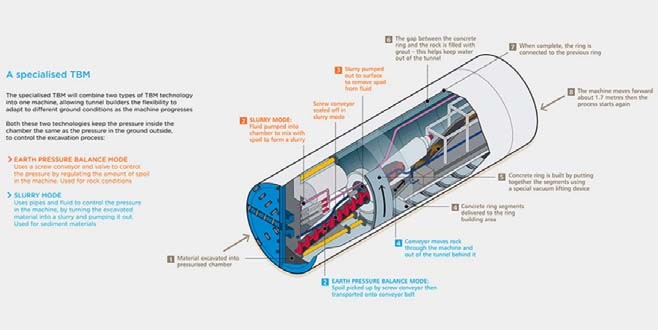

  • TBMs will be used to excavate 15.5 kilometers of new twin rail tunnels between Chatswood and Marrickville.
    • Estimated cost of TBM: $500k (-10%,+30%)
    • Tunneling cost: ($600k-$700k-$1b)/km, length3km
    • Expected tunneling duration: 6 month (-1mth,+3mths)

  • Sydney Metro City & Southwest needs fiveTBMs.
  • OtherConcerns:
    • Breakdown of TBM, very unlikely but if occurs, it may cause 1-2-4 months delay with the repair cost of$50k-$50k-$200k

Assignment 2: Project Risk Management & Contingency DeterminationOverview:Sydney Metro project details as

\f

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
