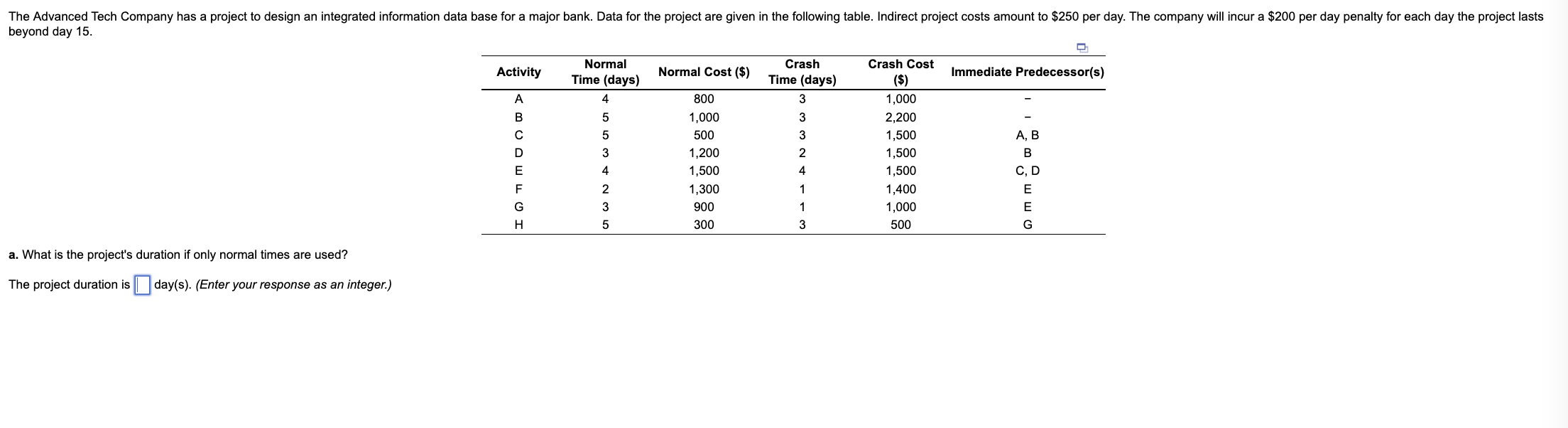

Question: beyond day 1 5 . begin { tabular } { cccccc } hline Activity & begin { tabular } { c }

beyond day 15.
\begin{tabular}{cccccc}
\hline Activity & \begin{tabular}{c}
Normal \\
Time (days)
\end{tabular} & Normal Cost (\$) & \begin{tabular}{c}
Crash \\
Time (days)
\end{tabular} & \begin{tabular}{c}
Crash Cost \\
(\$)
\end{tabular} & Immediate Predecessor(s)\\
\hline A & 4 & 800 & 3 & 1,000 & -\\
B & 5 & 1,000 & 3 & 2,200 & -\\
C & 5 & 500 & 3 & 1,500 & A, B \\
D & 3 & 1,200 & 2 & 1,500 & B \\
E & 4 & 1,500 & 4 & 1,500 & C, D \\
F & 2 & 1,300 & 1 & 1,400 & E \\
G & 3 & 900 & 1 & 1,000 & E \\
H & 5 & 300 & 3 & 500 & G \\
\hline
\end{tabular}
a. What is the project's duration if only normal times are used?
The project duration is day(s).(Enter your response as an integer.)
 beyond day 15. \begin{tabular}{cccccc} \hline Activity & \begin{tabular}{c} Normal \\ Time

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
