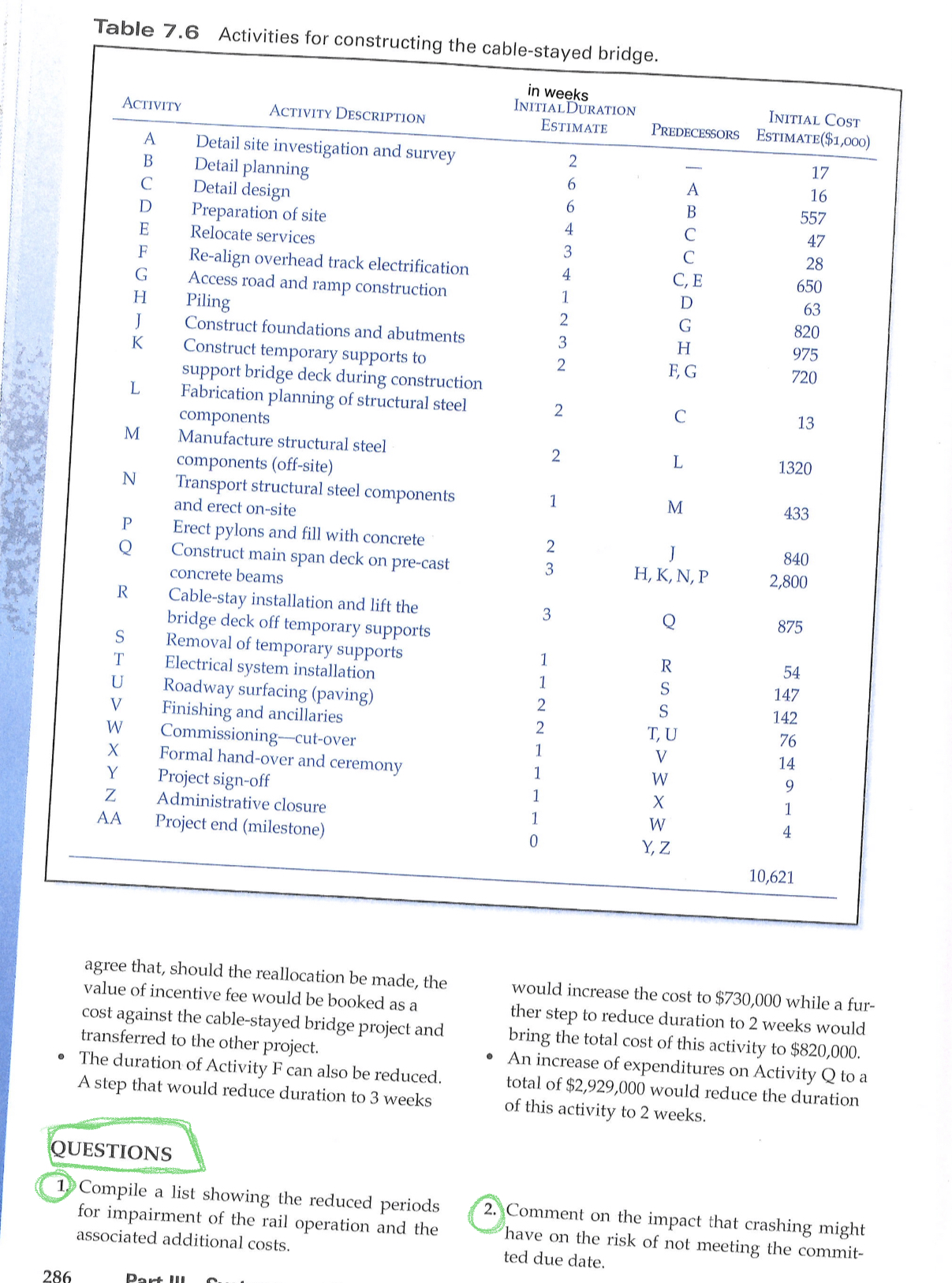

Question: Case 7-1: Bridgecon Contractors Bridgecon is a medium-size construction com- bridge indicates acceptance of the plan by the rail pany that specializes in the detail
