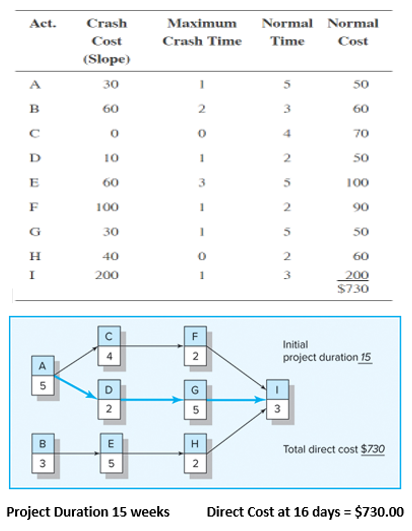

Question: Compute your responses to the three questions below based on the following Data, Table, and Diagram. The indirect costs for this project are $90 at
Compute your responses to the three questions below based on the following Data, Table, and Diagram. The indirect costs for this project are $90 at 15 days, $70 at 14 days, $50 at 13 days, $30 at 12 days, and $10 at 11 days. Your original Project Duration is 15 days with a Direct cost of $730.

1. What is the Maximum Crashed Duration for this entire Project ? ___________4 pts.
2. What is the Optimum Crash Cost ? _____________3 pts.
What is the Optimum Crash Duration? ____________3 pts.
Project Duration 15 weeks DirectCostat16days=$730.00Step by Step Solution
There are 3 Steps involved in it
