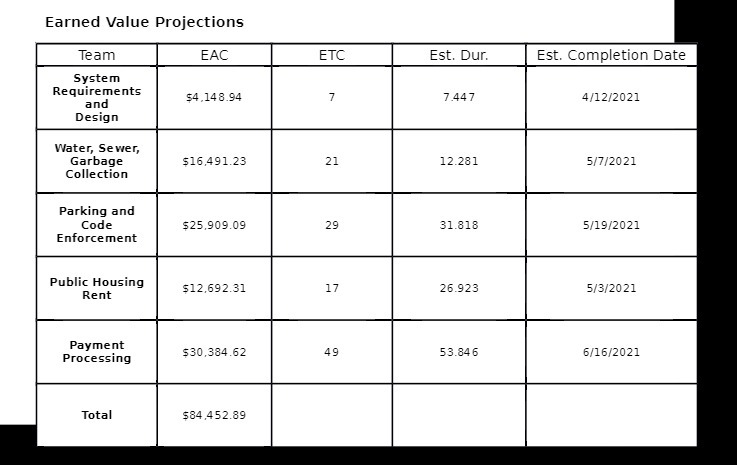

Question: Earned Value Projections Team EAC ETC Est. Dur. Est. Completion Date System Requirements $4.148.94 7 7.447 4/12/2021 and Design Water, Sewer, Garbage $16,491.23 21 12.281

Earned Value Projections Team EAC ETC Est. Dur.
Earned Value Projections Team EAC ETC Est. Dur. Est. Completion Date System Requirements $4.148.94 7 7.447 4/12/2021 and Design Water, Sewer, Garbage $16,491.23 21 12.281 5/7/2021 Collection Parking and Code $25,909.09 29 31.818 5/19/2021 Enforcement Public Housing $12.692.31 17 26.923 5/3/2021 Rent Payment Processing $30,384.62 49 53.846 6/16/2021 Total $84.452.89
