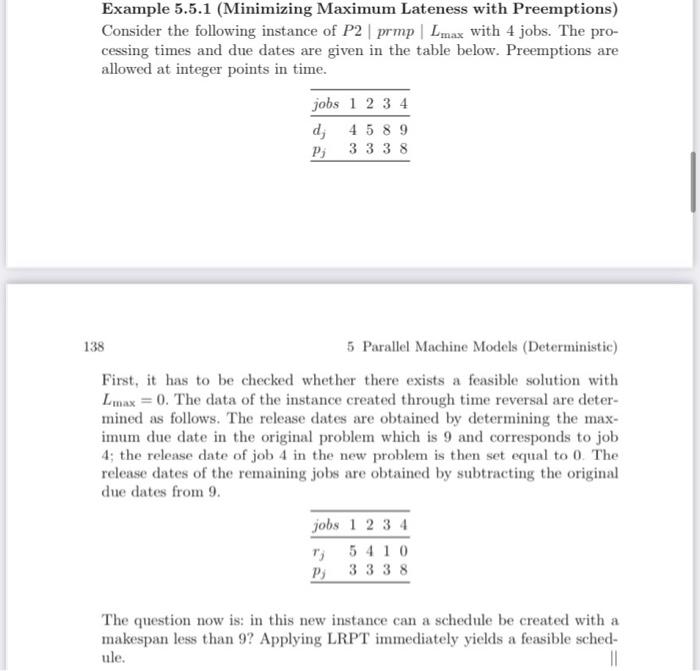

Question: Example 5.5.1 (Minimizing Maximum Lateness with Preemptions) Consider the following instance of P2 prmp Lmax with 4 jobs. The processing times and due dates are
