Question: Find the current project completion time and project cost. Accelerate the project as much as possible - compress the schedule optimally. What is the crashed

Find the current project completion time and project cost.

Accelerate the project as much as possible - compress the schedule optimally. What is the crashed project completion time and what is the associated crashed project cost. Find the current project completion time and

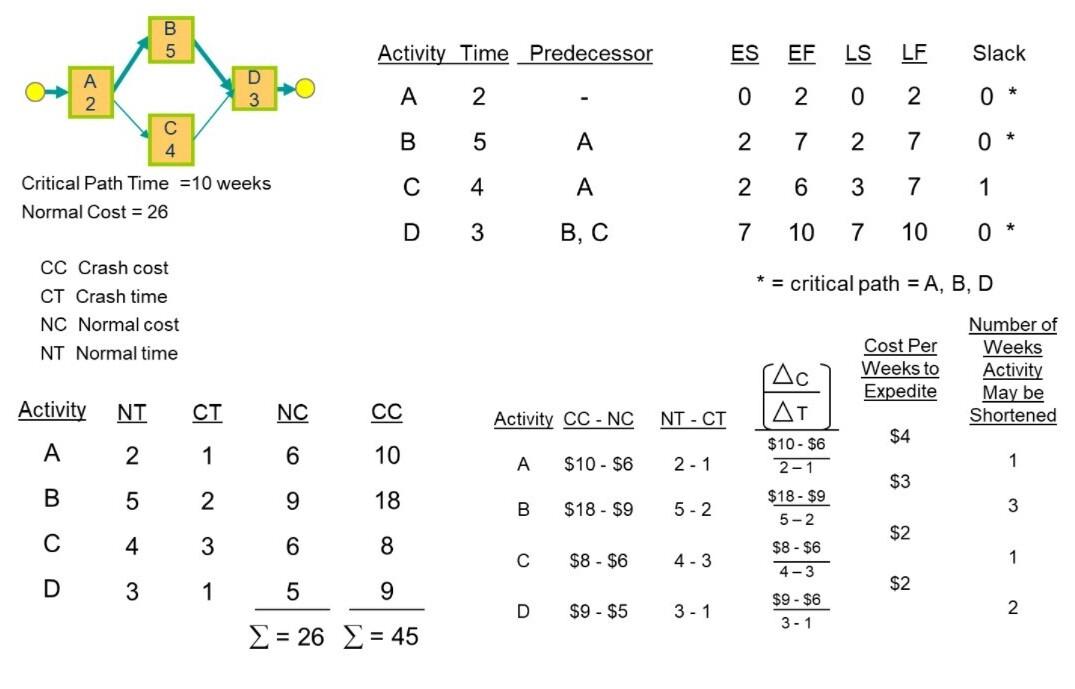

B 5 Activity Time Predecessor ES EF LS LF Slack A 2 * 2 A 0 2 0 2 0 4 B 5 2 7 2 7 O * C 4 A 2 6 3 7 1 Critical Path Time = 10 weeks Normal Cost = 26 D 3 B, C 7 10 7 10 O * * = critical path = A, B, D CC Crash cost CT Crash time NC Normal cost NT Normal time (Ac AI Cost Per Weeks to Expedite Number of Weeks Activity May be Shortened Activity NT NC CC Activity CC - NC NT-CT $4 A 2 1 6 10 . A $10 - $6 $10-$6 2-1 2-1 1 $3 B 5 2 9 Fe 8 9 18 B $18 - $9 5 - 2 $18 - $9 5-2 3 $2 C 4 3 6 $8 - $6 4-3 $8 - $6 4-3 1 D 3 1 5 $2 D $9 - $5 3 - 1 $9 - $6 3-1 2 = 26 = 45

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
